City Rail Link construction

Following the construction of the City Rail Link between Britomart and Mt Eden, from enabling works to project completion
424 photos in this gallery. Showing photos 385 - 424

With above ground track work now complete, the new Maungawhau junction is on near-full display, with these three tracks passing underneath Normanby Road

18 January 2025

Looking the other way from Normanby Road itself, the centre link track to the CRL tunnel meets the Up Main before the tracks head to Grafton

18 January 2025

On the other side of Normanby Road, the fourth track splits from the Down Main and heads down into the new tunnel

18 January 2025

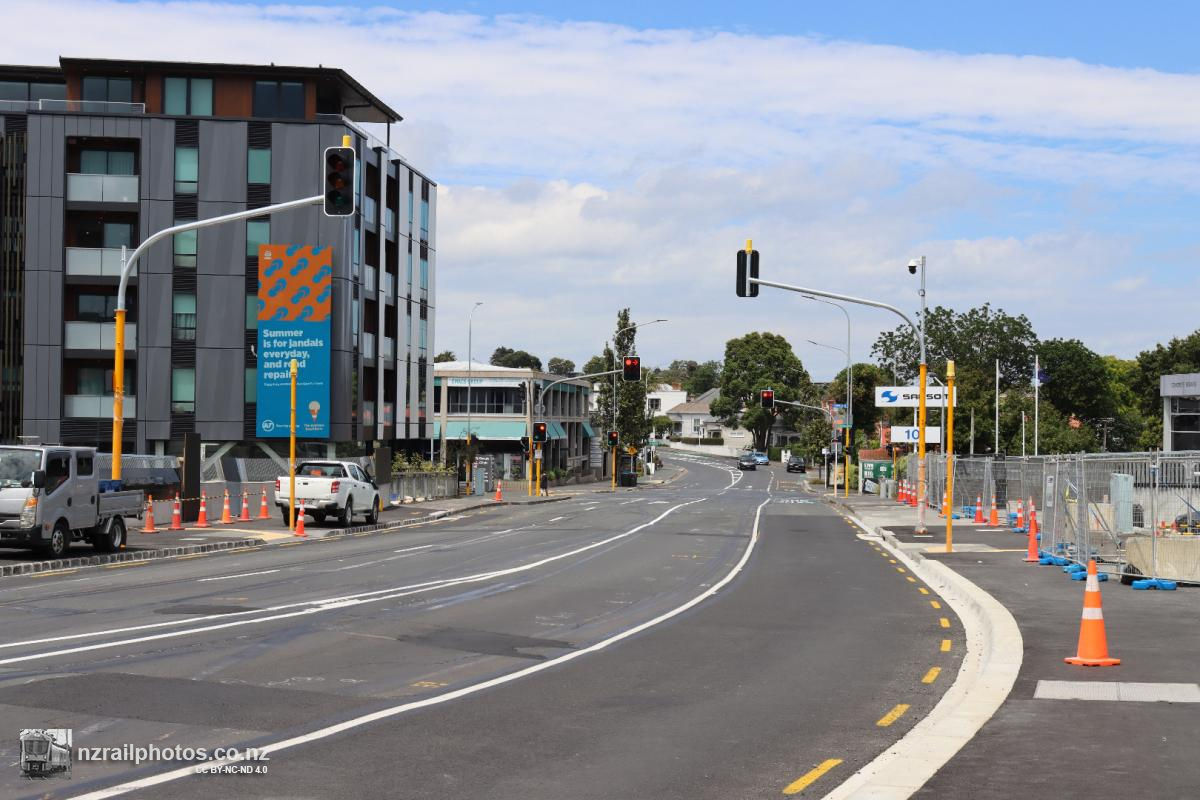

As part of the station streetscaping works, a new access path for pedestrians and cyclists to access Maungawhau station is under construction. This signalised pedestrian crossing on Mt Eden Road will connect to the new lane

18 January 2025

The under-construction Ruru Lane, leading from Mt Eden Road to Maungawhau station. The lane will be vehicle-free aside from service vehicles, and will otherwise be exclusively for pedestrians, cyclists and scooters

18 January 2025

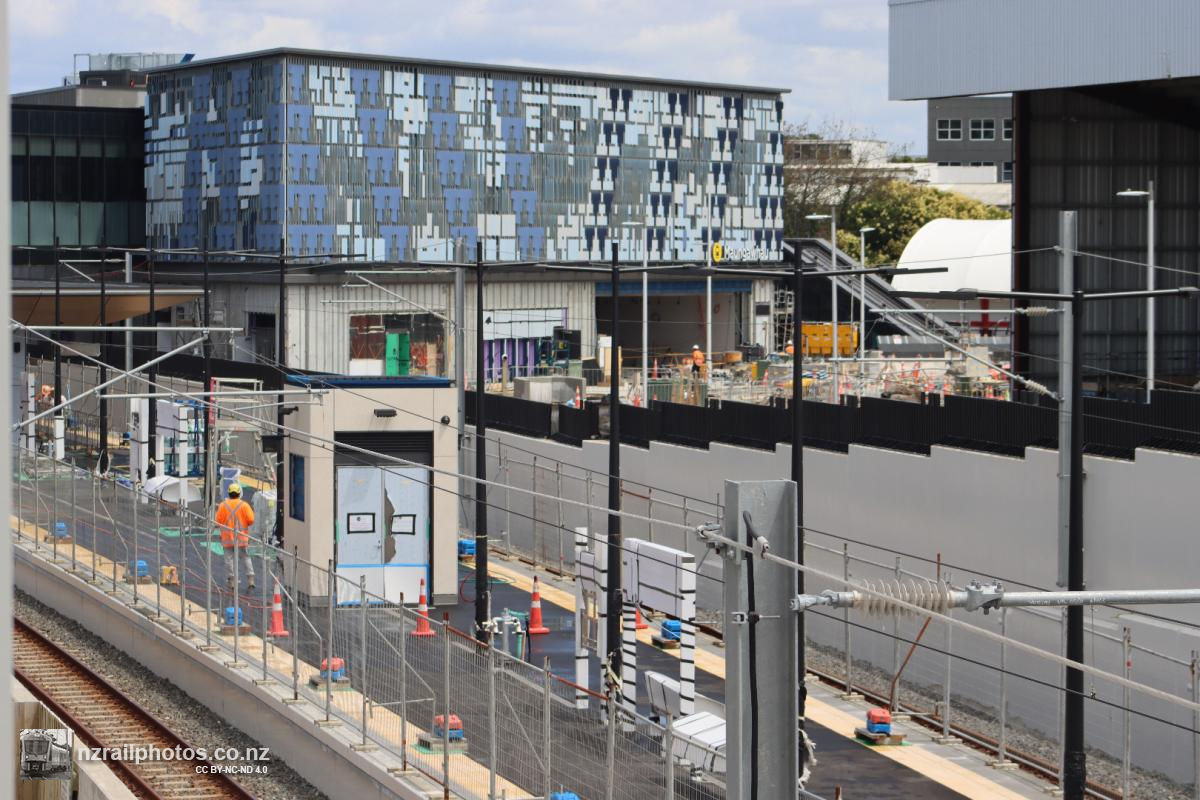

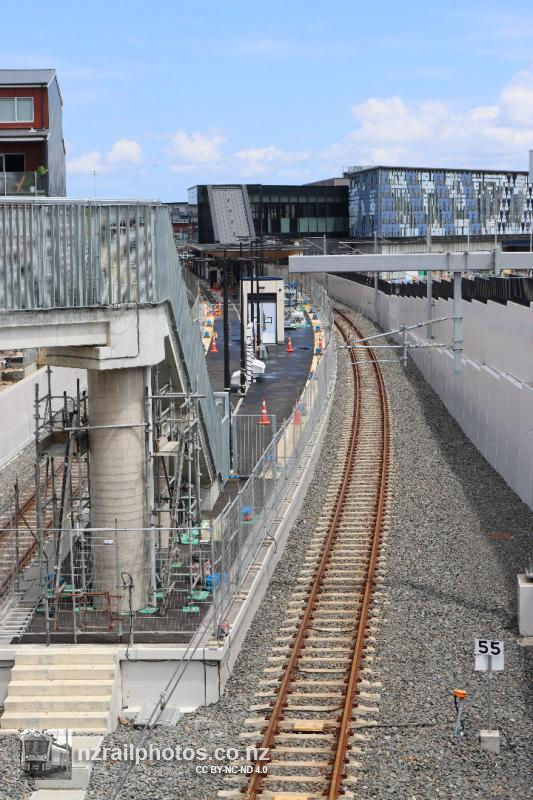

The nearly-complete station platform at Maungawhau, on the North Auckland Line portion. The platform appears to be nearing completing, with signage and benches installed

18 January 2025

"Feature" signage has also been installed on the station buildings, including at Maungawhau. The station building here rises above the platforms heading into the tunnel, with streetscaping work in front

18 January 2025

The station building and NAL platform, with signage appearing on both

18 January 2025

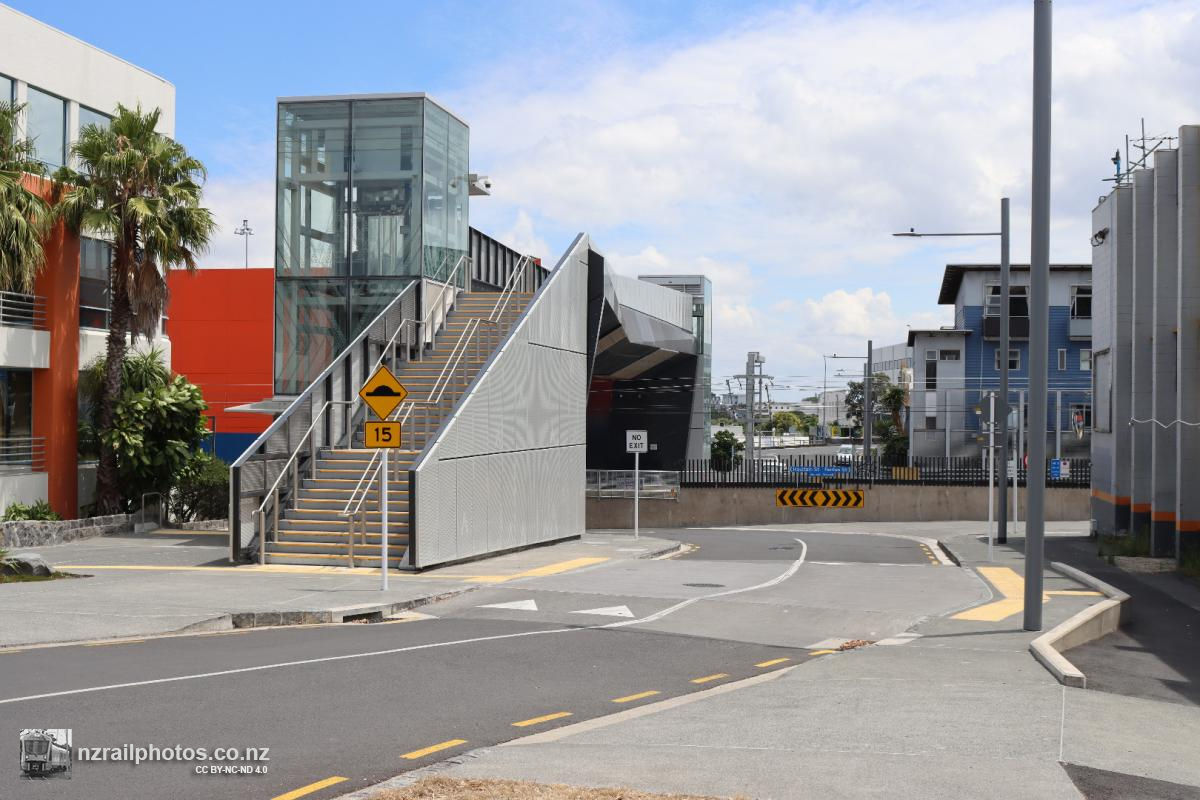

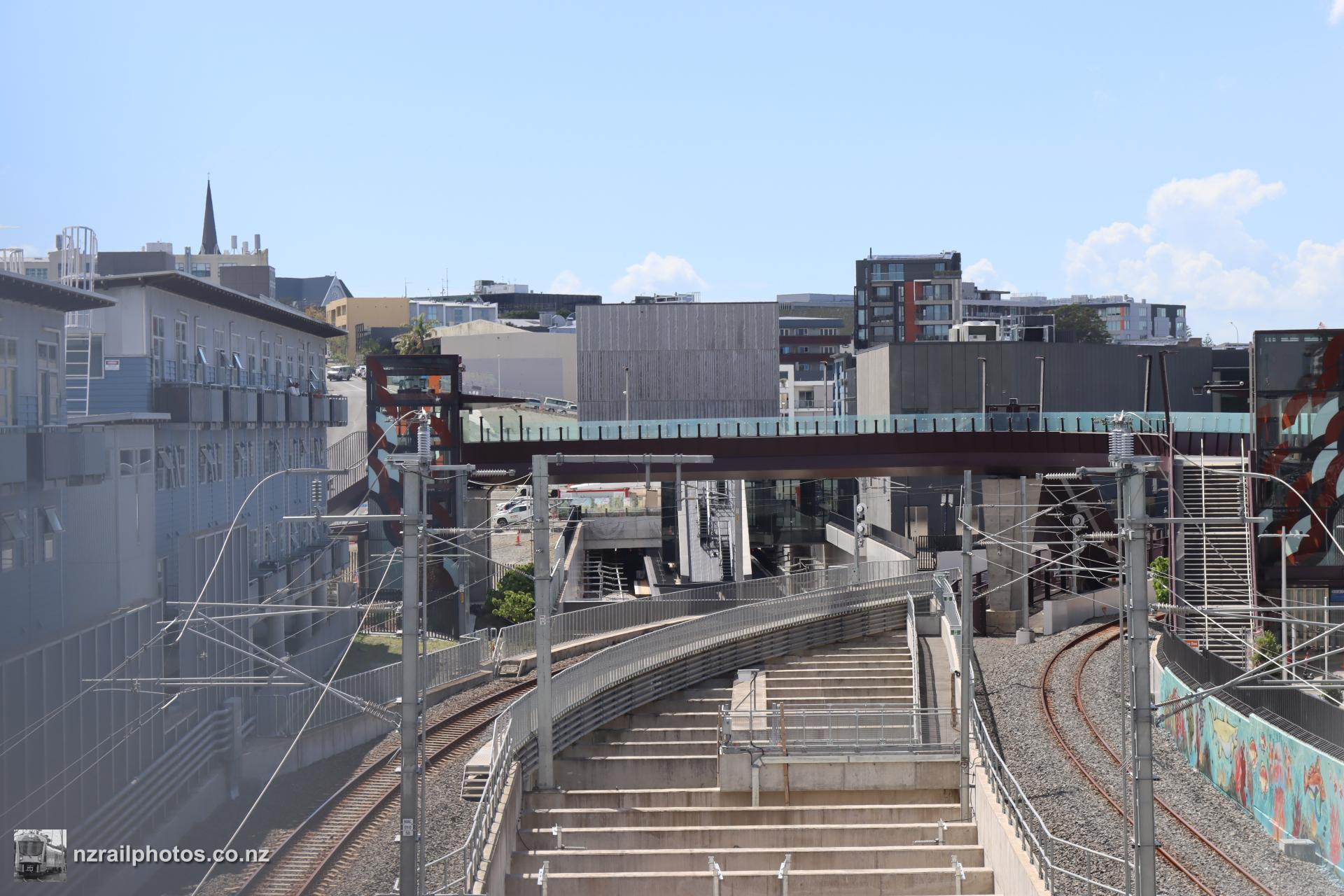

Viewed from Mt Eden Road, three of the four tracks running through this area are visible, with the trench the fourth is in also visible

18 January 2025

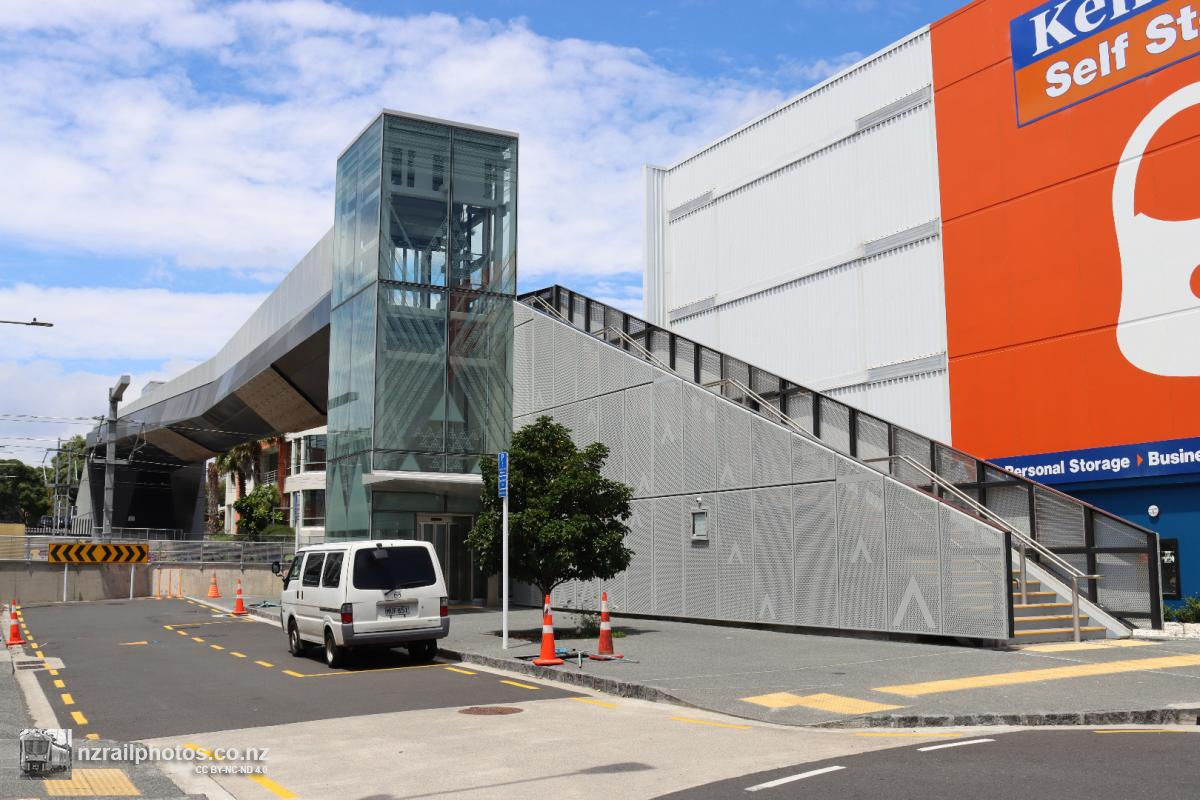

At Porters Ave, road works in the area have been completed, with the new pedestrian bridge now leading down onto a finished footpath. No trace of the level crossing that was once here remains

18 January 2025

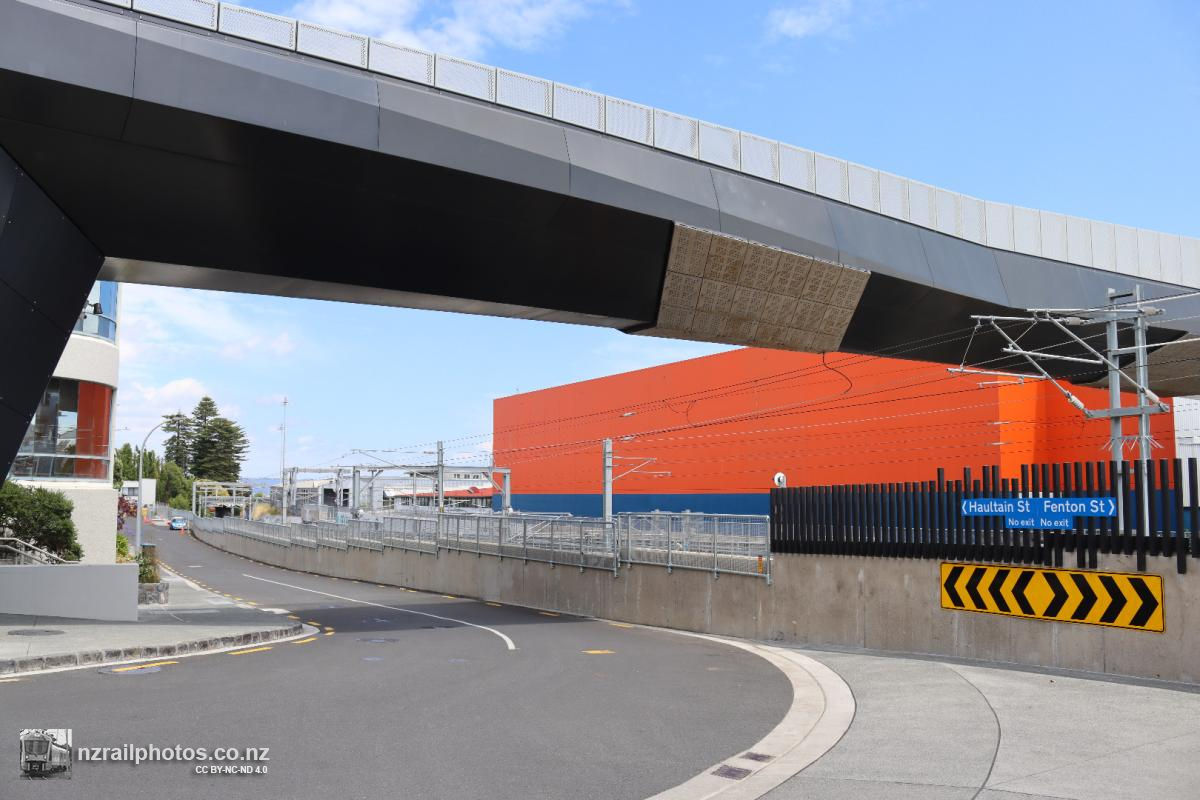

Underneath the footbridge, Wynyard Road turns into Haultain Street and continues as one road, with Fenton Street branching off. Previously, Wynyard Road became Porters Ave at this intersection and carried on across the railway

18 January 2025

The other side of the Porters Ave bridge is also now completed, with some road cones still remaining

18 January 2025

From the Porters Ave bridge, the new Fenton Street bridge is also visible, replacing the pedestrian level crossing at the western end of Mt Eden station (now Maungawhau)

18 January 2025

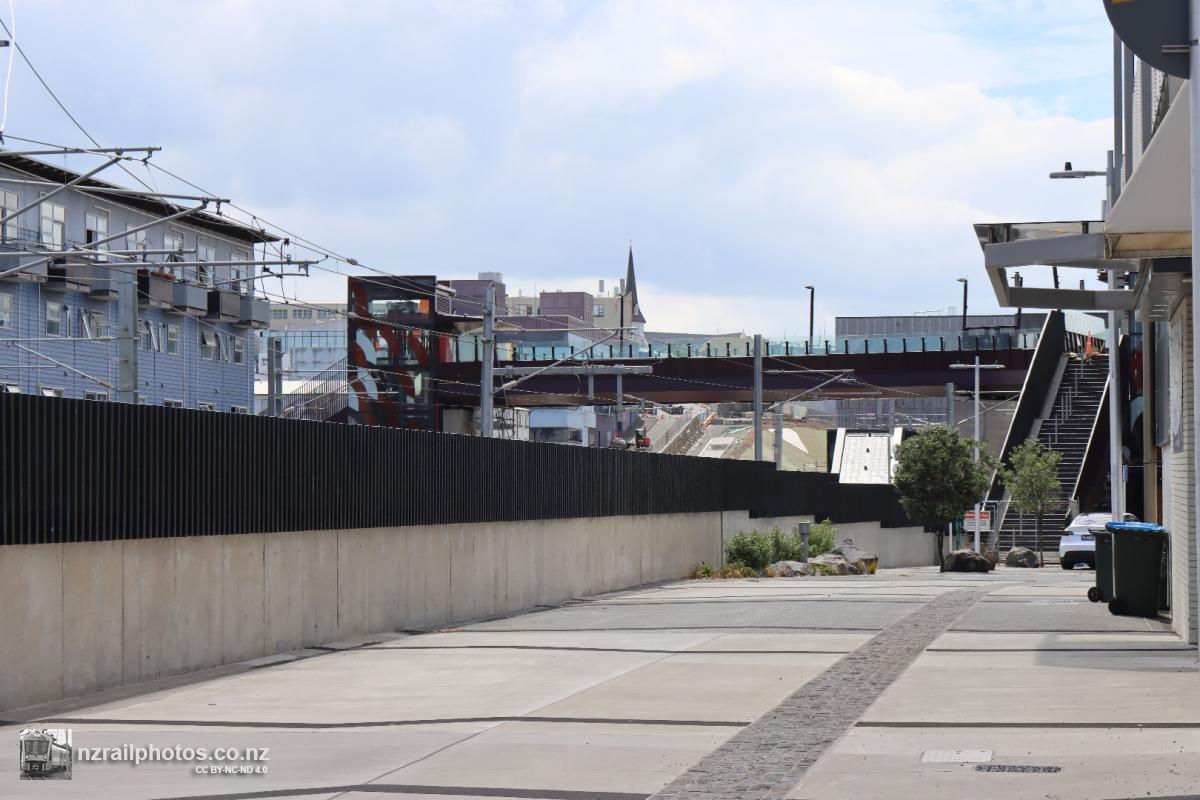

Fenton Street has been rebuilt as a shared space, with the new footbridge connecting to this street

18 January 2025

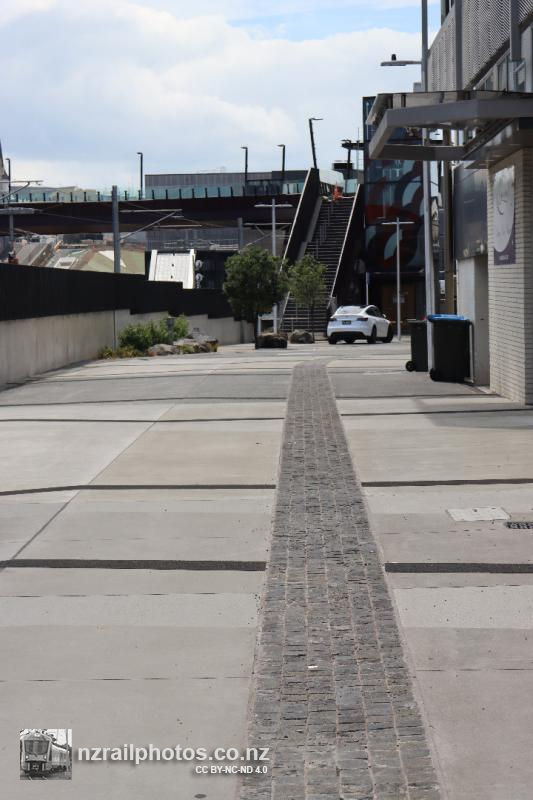

Looking along the new shared space of Fenton Street, with the stairs of the new bridge in the background

18 January 2025

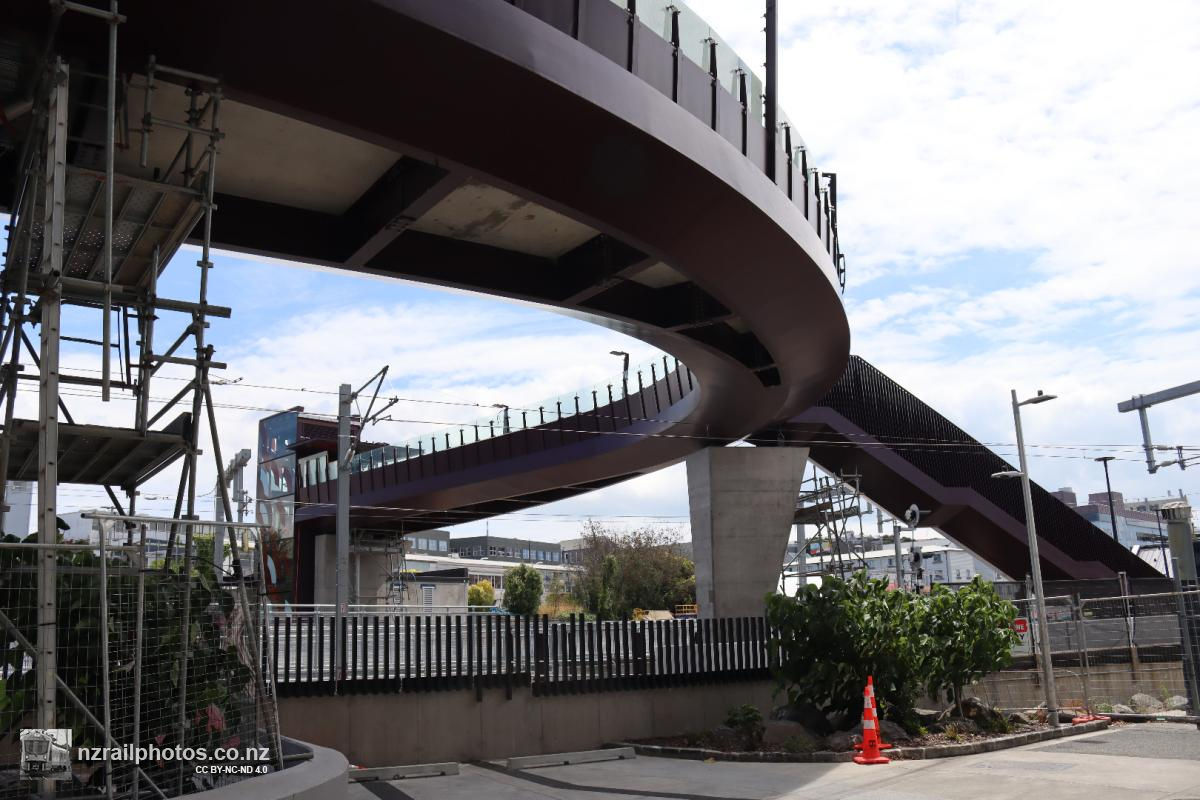

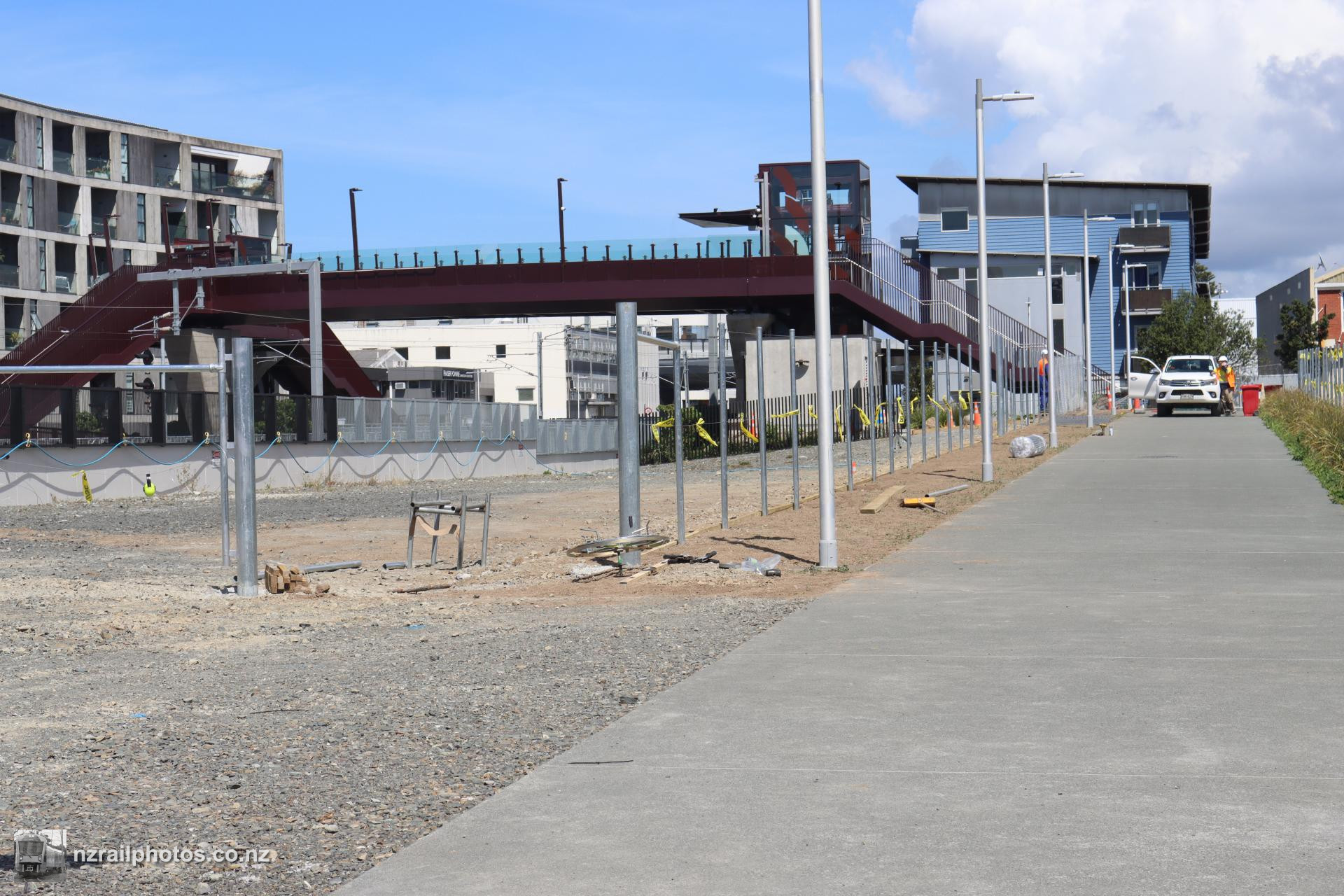

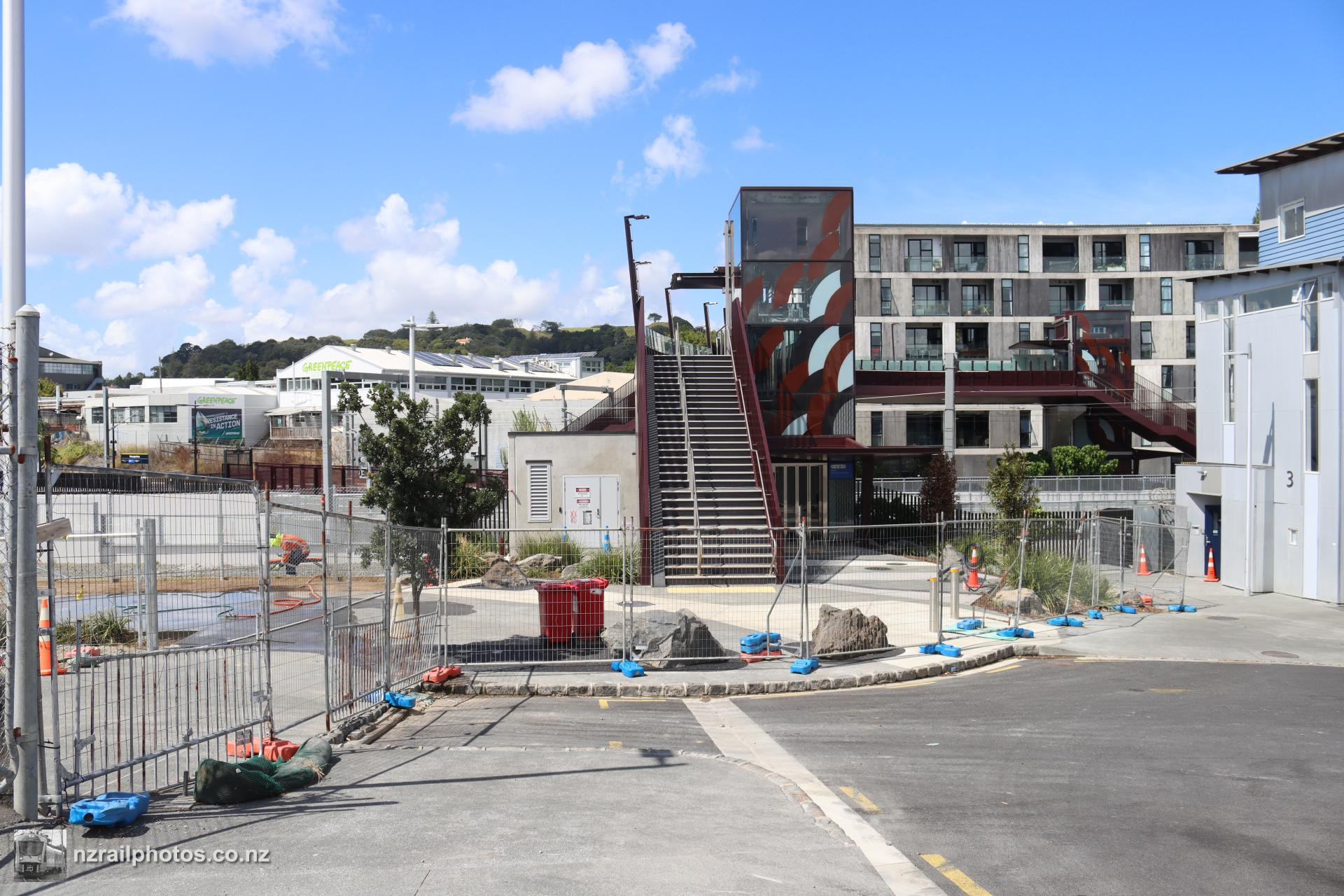

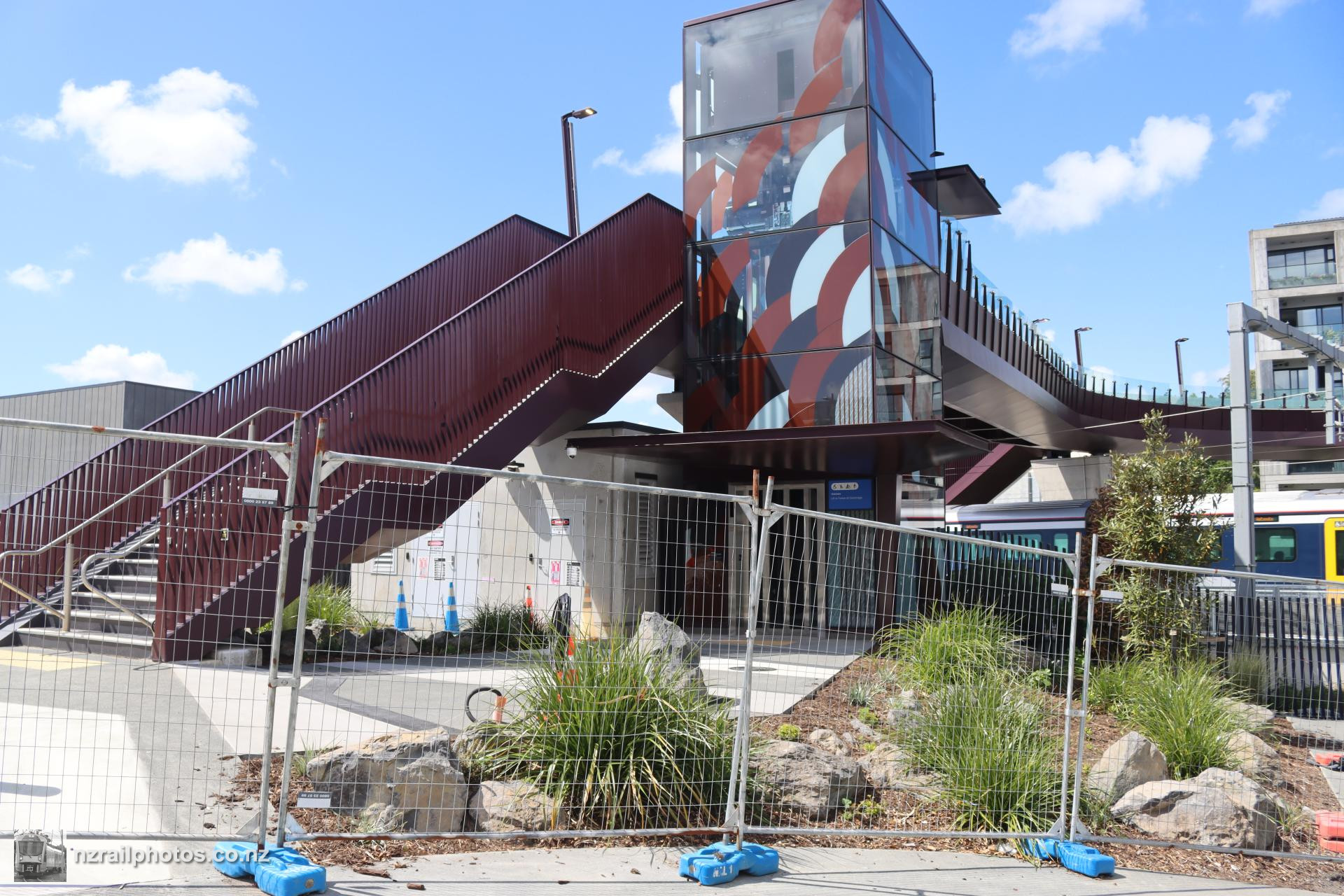

The new Fenton Street bridge is largely complete, though not yet open to the public. On this side, it appears as if handrails and final lift work is still to be done

18 January 2025

Underneath the Fenton Street bridge, with its unique curved shape. The bridge provides access across the tracks, as well as access to the NAL platforms

18 January 2025

Viewed from Ngahura Street, the Fenton Street bridge currently leads down into a construction site, with streetscaping still to be done in this area

18 January 2025

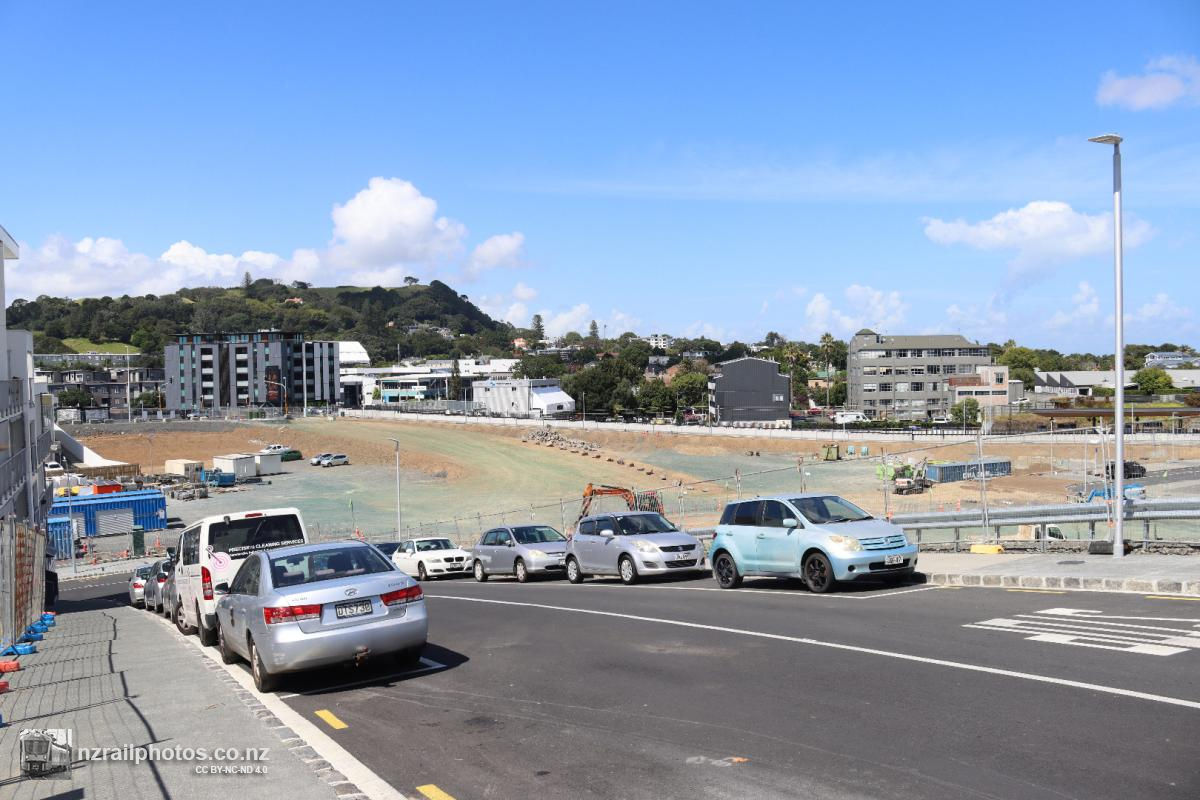

North of the station side, streetscaping is under way, creating a plaza and new roads for access to Maungawhau station

18 January 2025

The northern side of the Fenton Street bridge, currently leading into gravel as footpath work in this area is not yet completed

18 January 2025

The curved Fenton Street bridge from Ngahura Street

18 January 2025

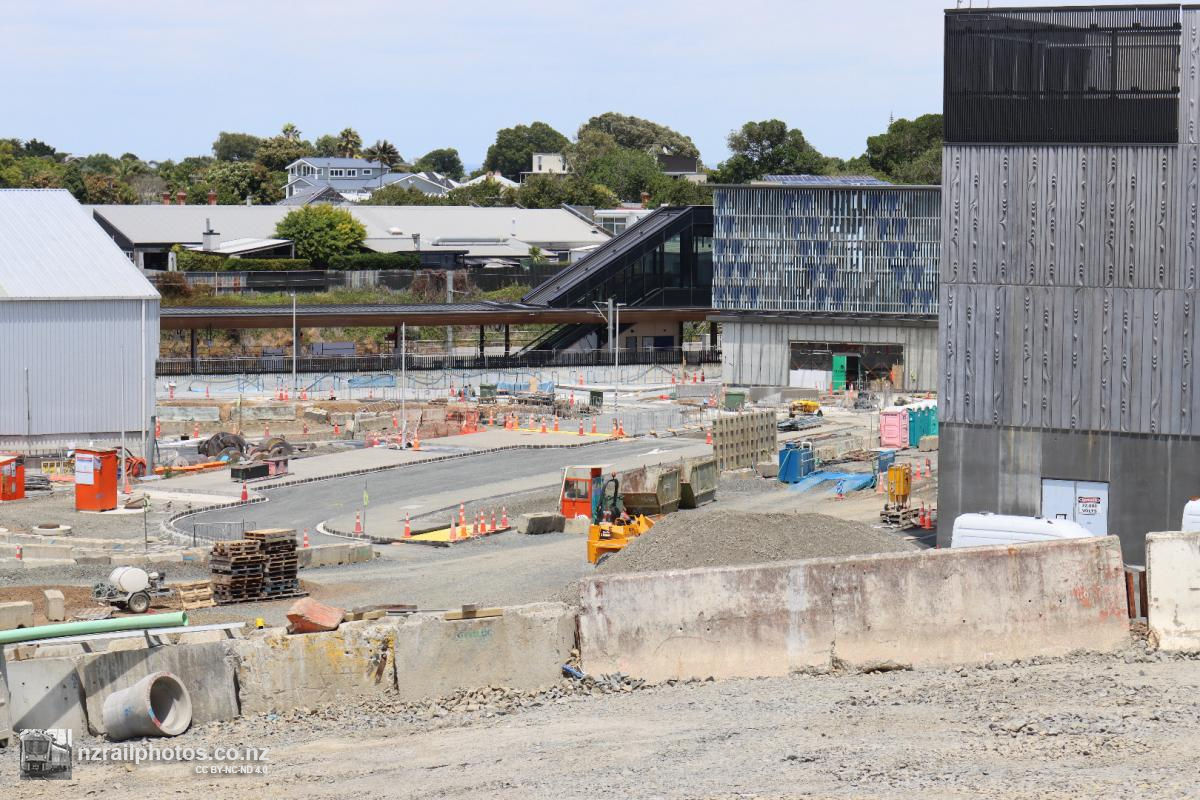

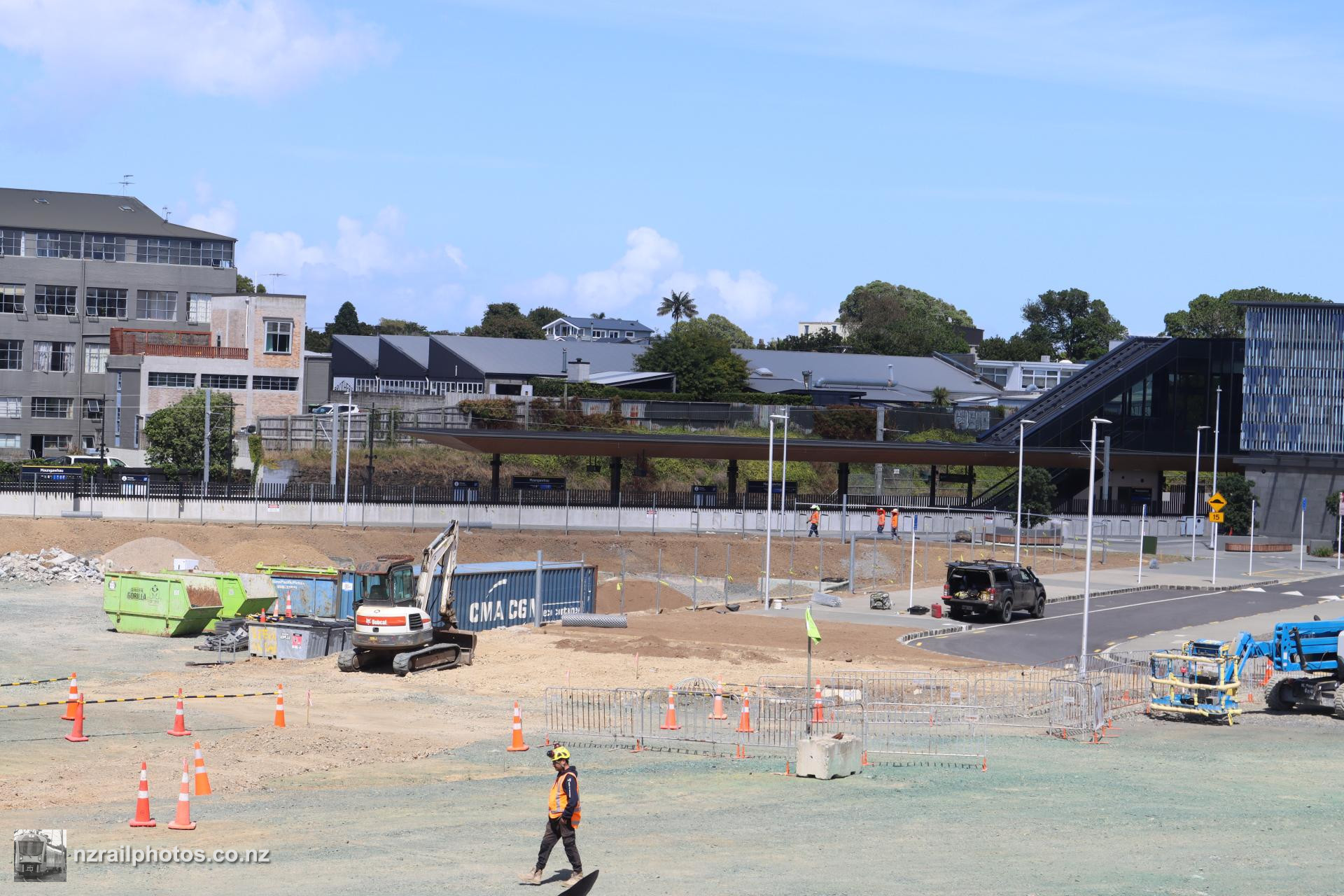

From the top of Ruru Street, the station building and the NAL platforms are visible, with surface level works under way

18 January 2025

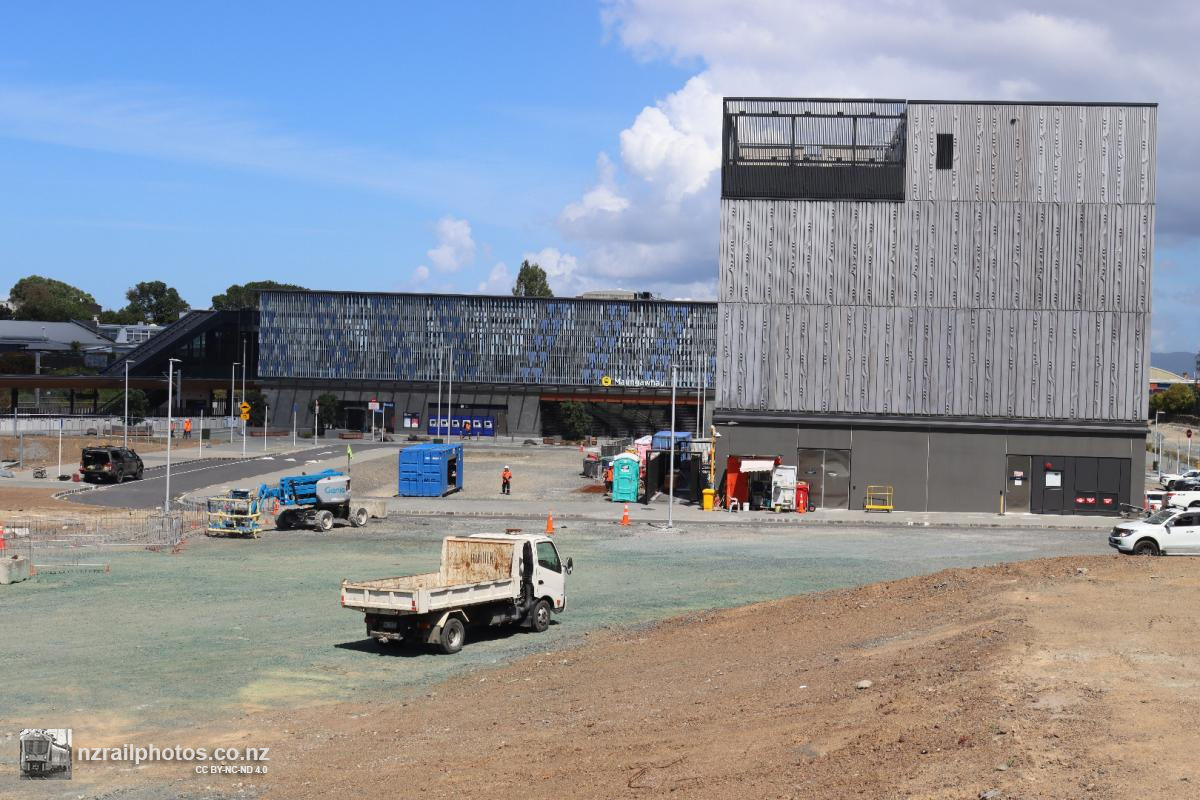

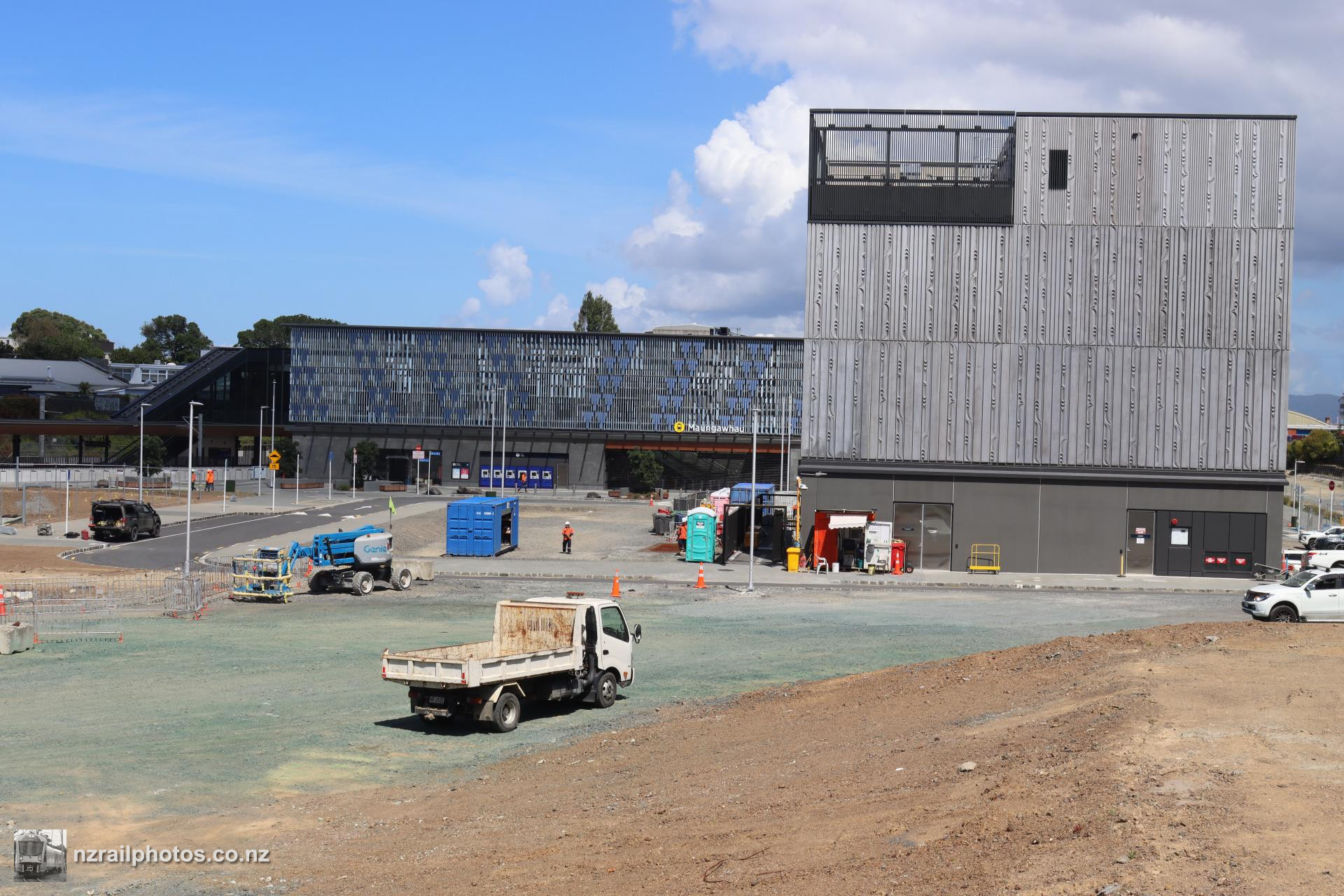

Maungawhau's new station building, with access to the tunnel platforms visible to the right

18 January 2025

Above the tunnel portal, the land has been backfilled back to its original height, and construction on top is now under way

18 January 2025

Viewed from further up Ruru Street, with some roads in the area visible already

18 January 2025

Machinery starting work on the eastern side of the new streets

18 January 2025

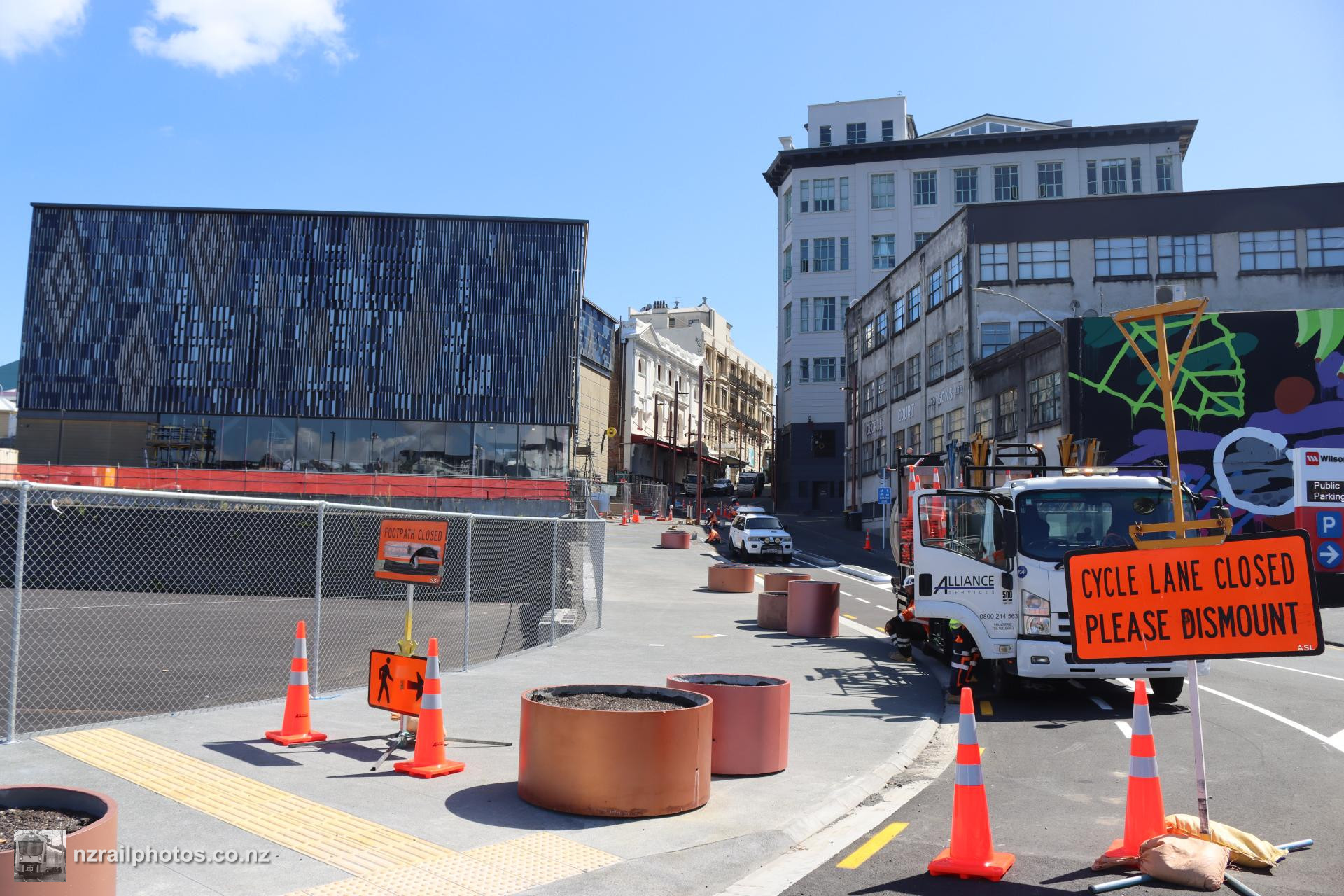

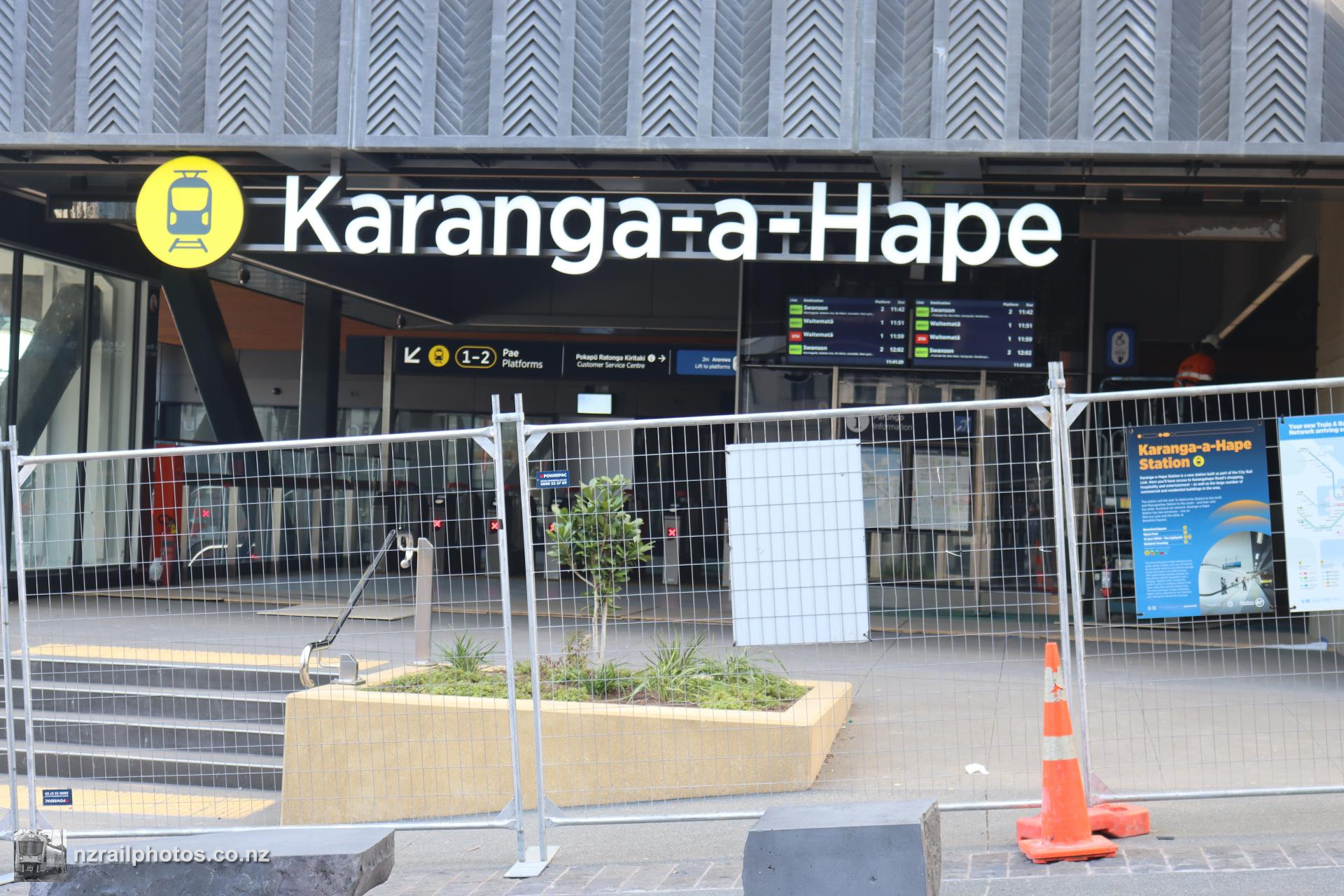

Further north, the exterior of Karanga-a-Hape station has now largely taken shape

18 January 2025

A look through the fences around the station building gives us a small peek inside

18 January 2025

Outside the station, upgrades to Mercury Lane are in progress, to support large numbers of passengers using the station in the future

18 January 2025

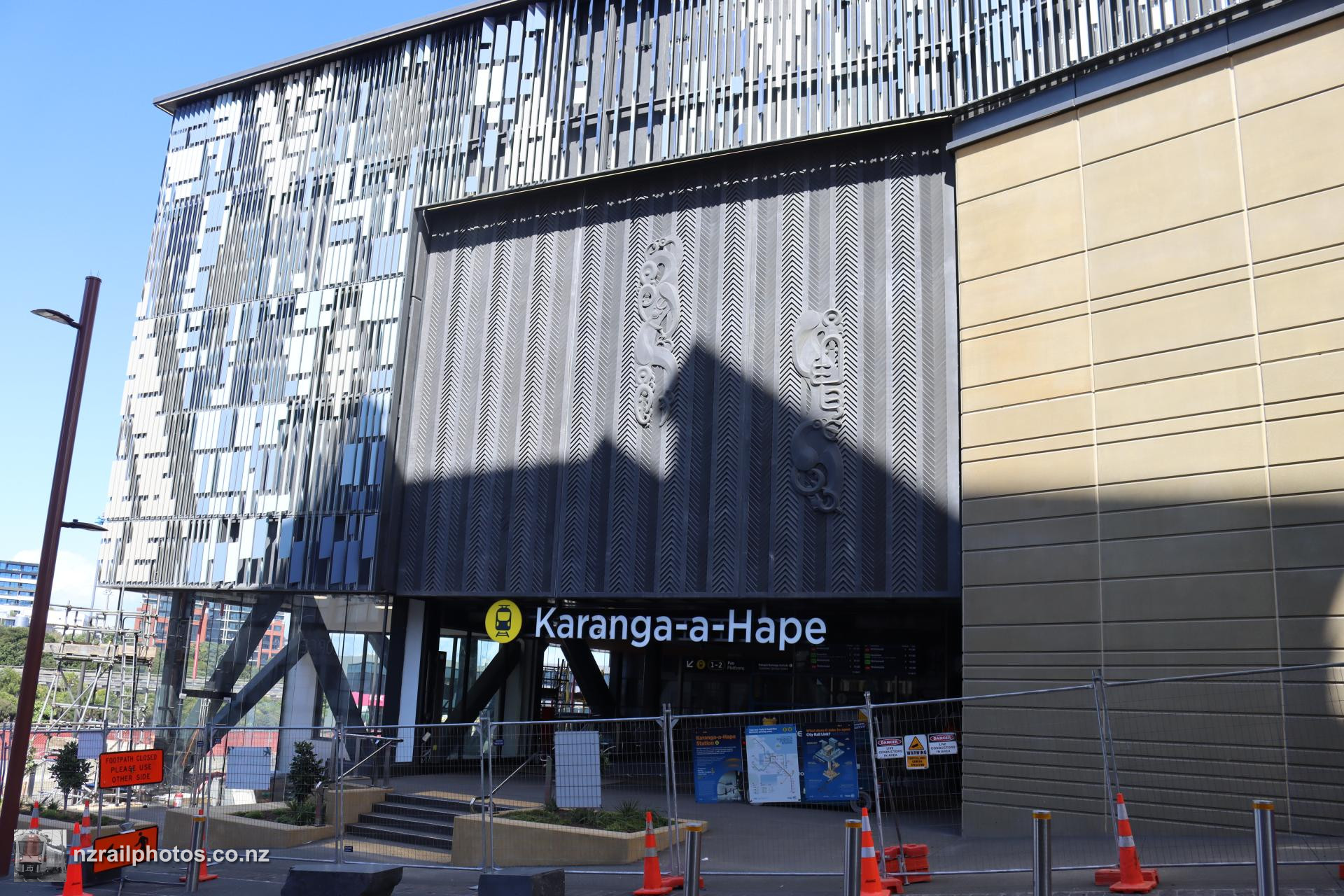

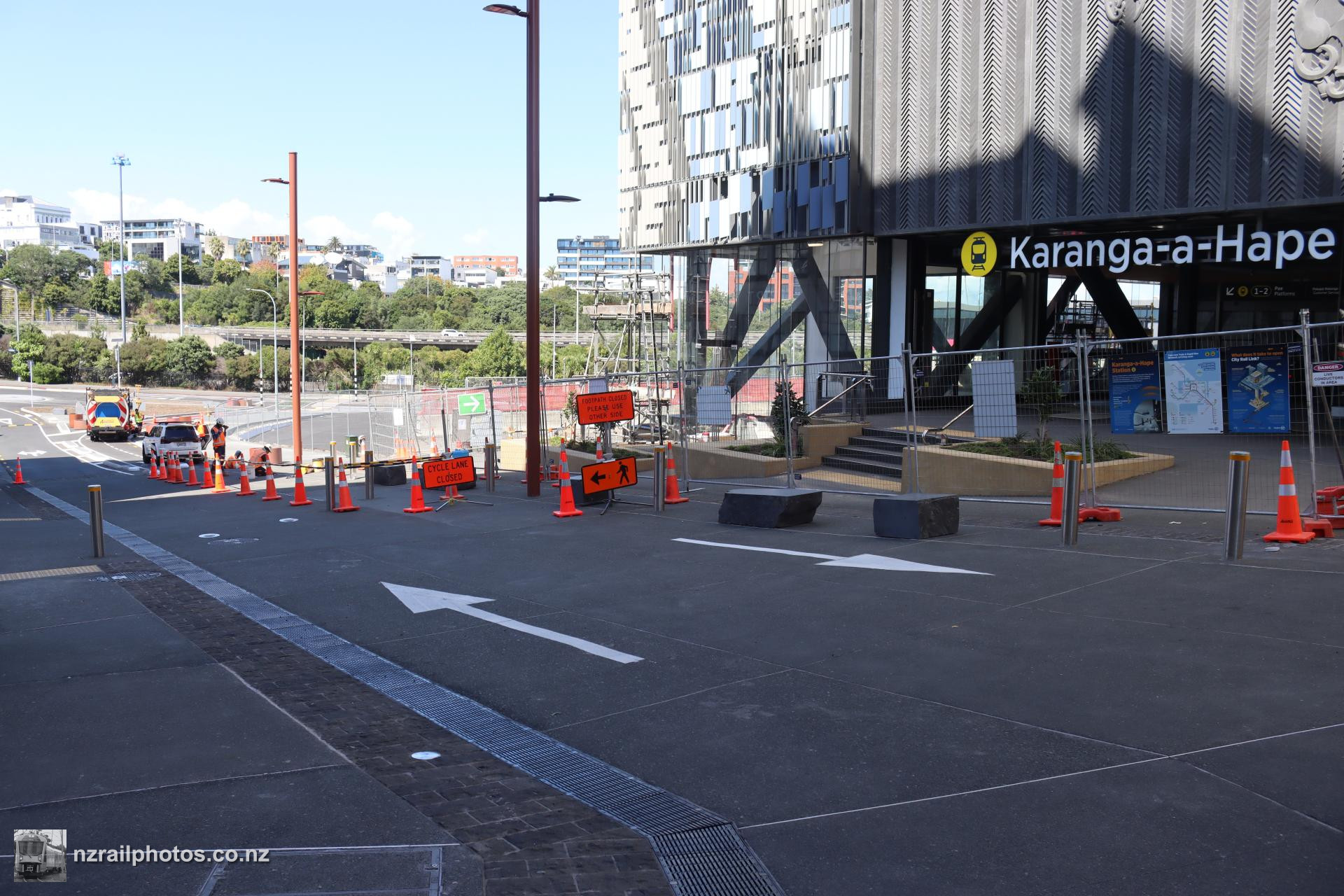

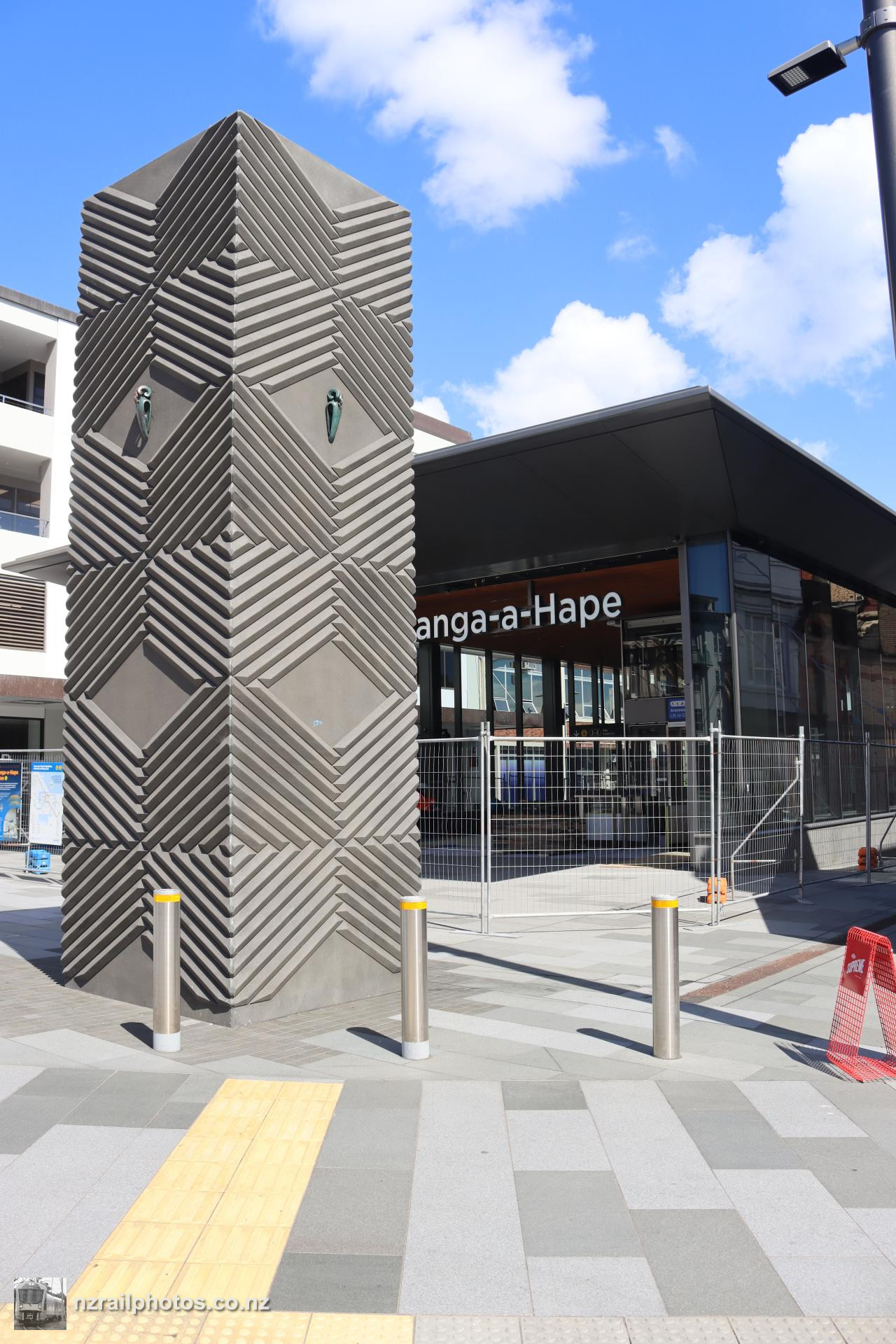

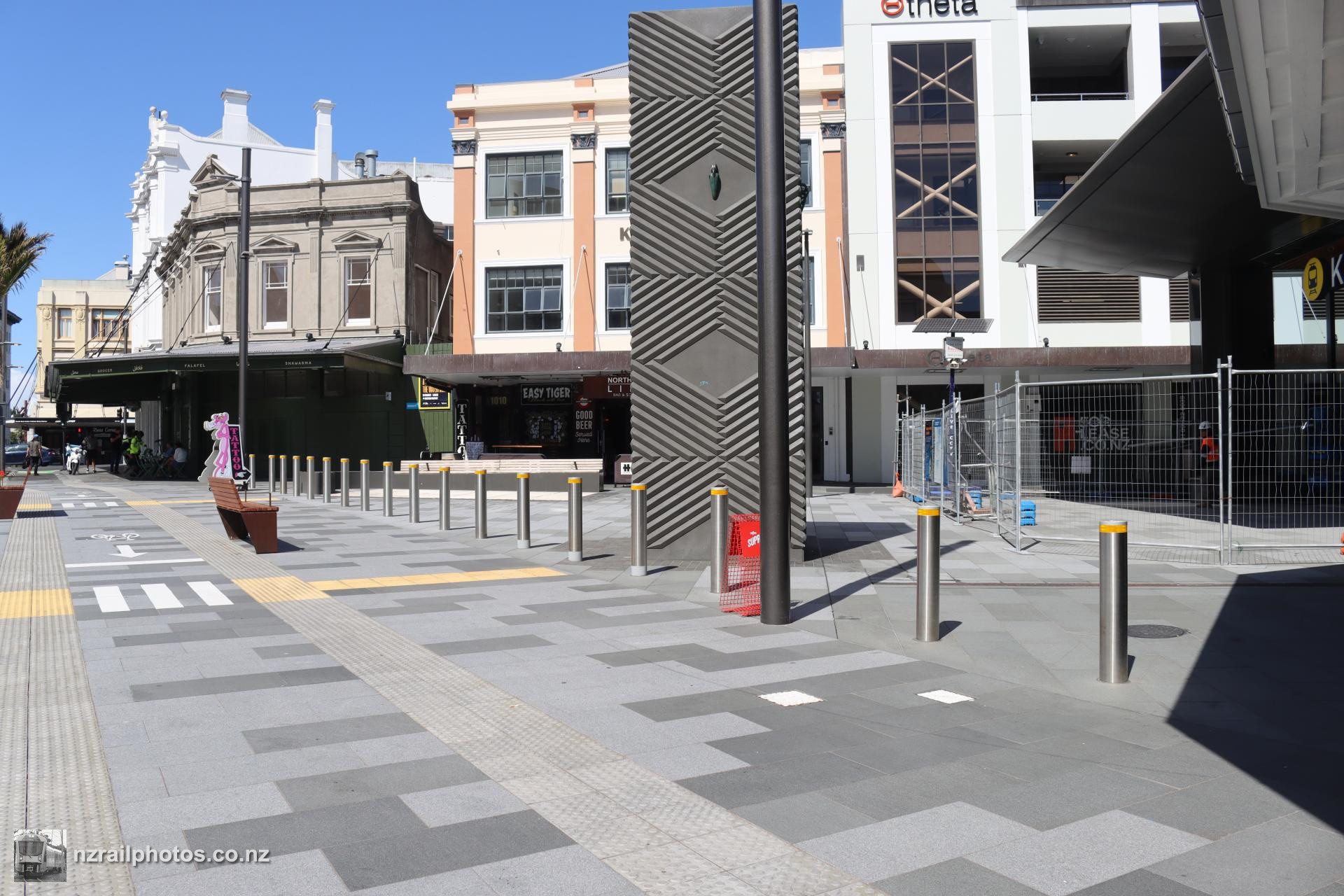

The Beresford Square entrance to Karanga-a-Hape station now looks like a proper entrance, with some exterior work still to go

18 January 2025

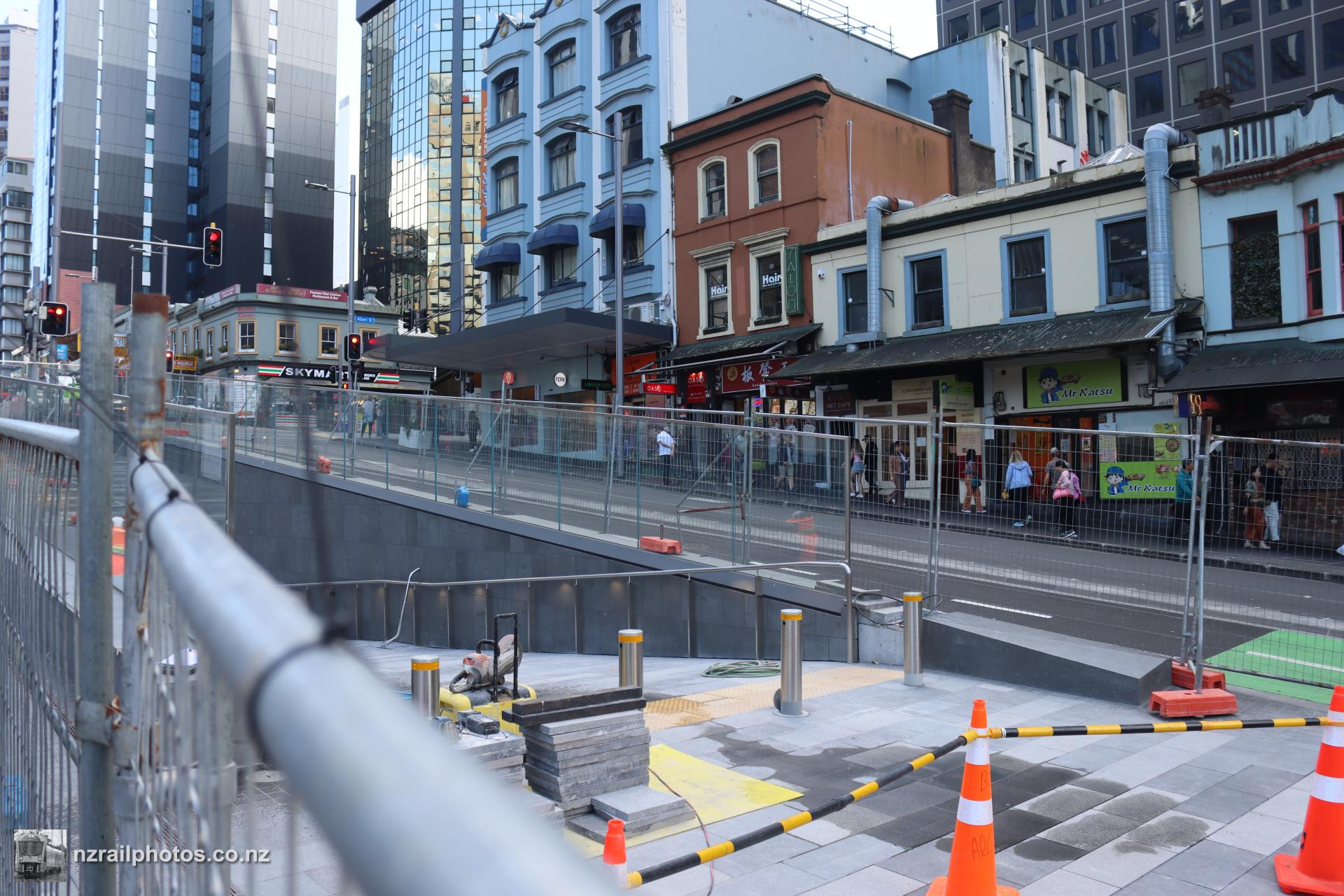

Closer to the centre of the city, the Victoria Street West entrance to Te Waihorotiu station is now firmly in place

18 January 2025

The entrance to Te Waihorotiu in this area fits nicely with the newly rebuilt footpaths

18 January 2025

Te Waihorotiu station entrance sits on Victoria Street, just 150 metres from the city's most well-known landmark, the Sky Tower

18 January 2025

Te Waihorotiu station entrance, ready to become part of the busiest railway station in the country

18 January 2025

The Sky Tower rising above the Victoria Street West entrance of Te Waihorotiu station. The base of the tower is just 150 metres from this location, giving easy access from rail services

18 January 2025

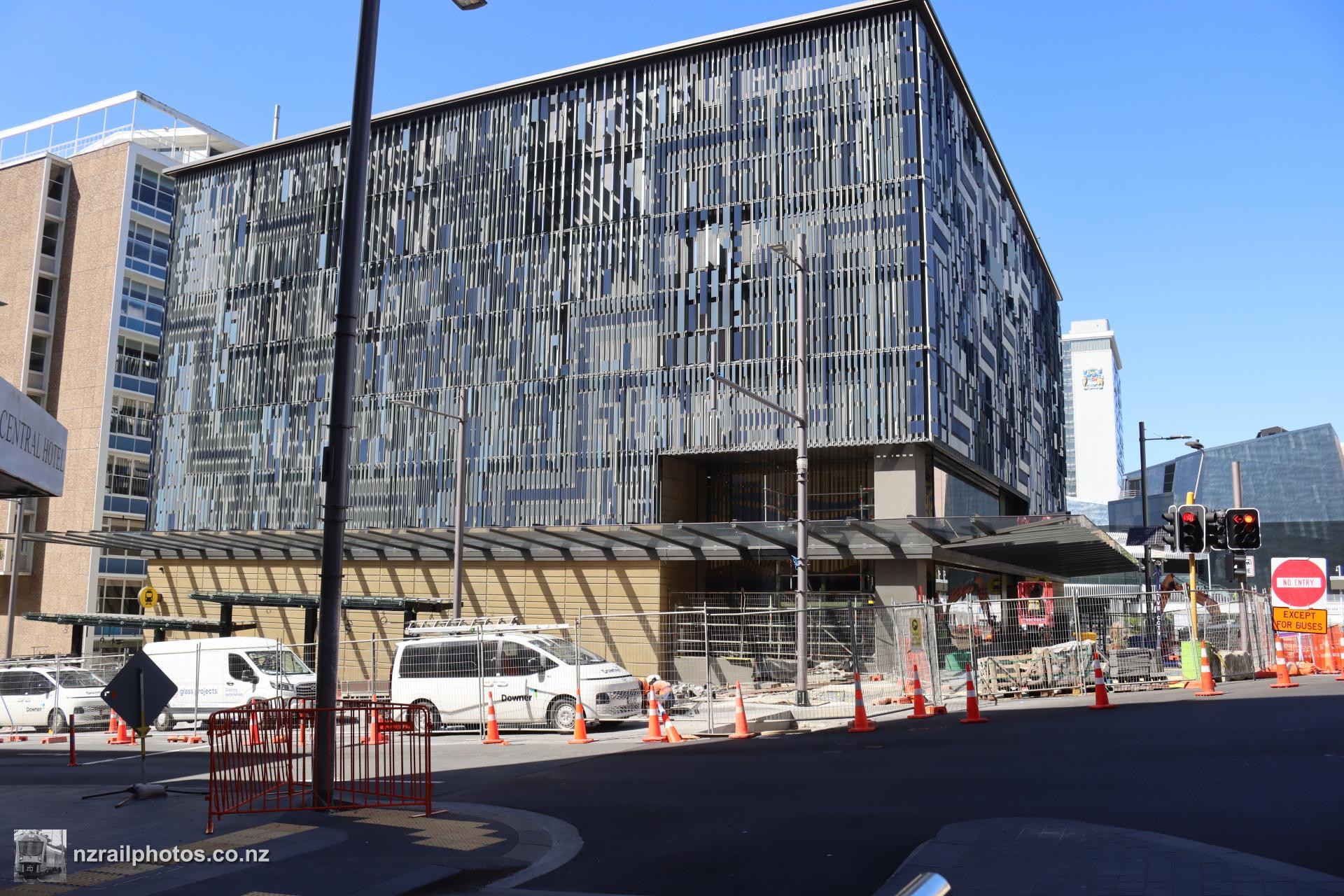

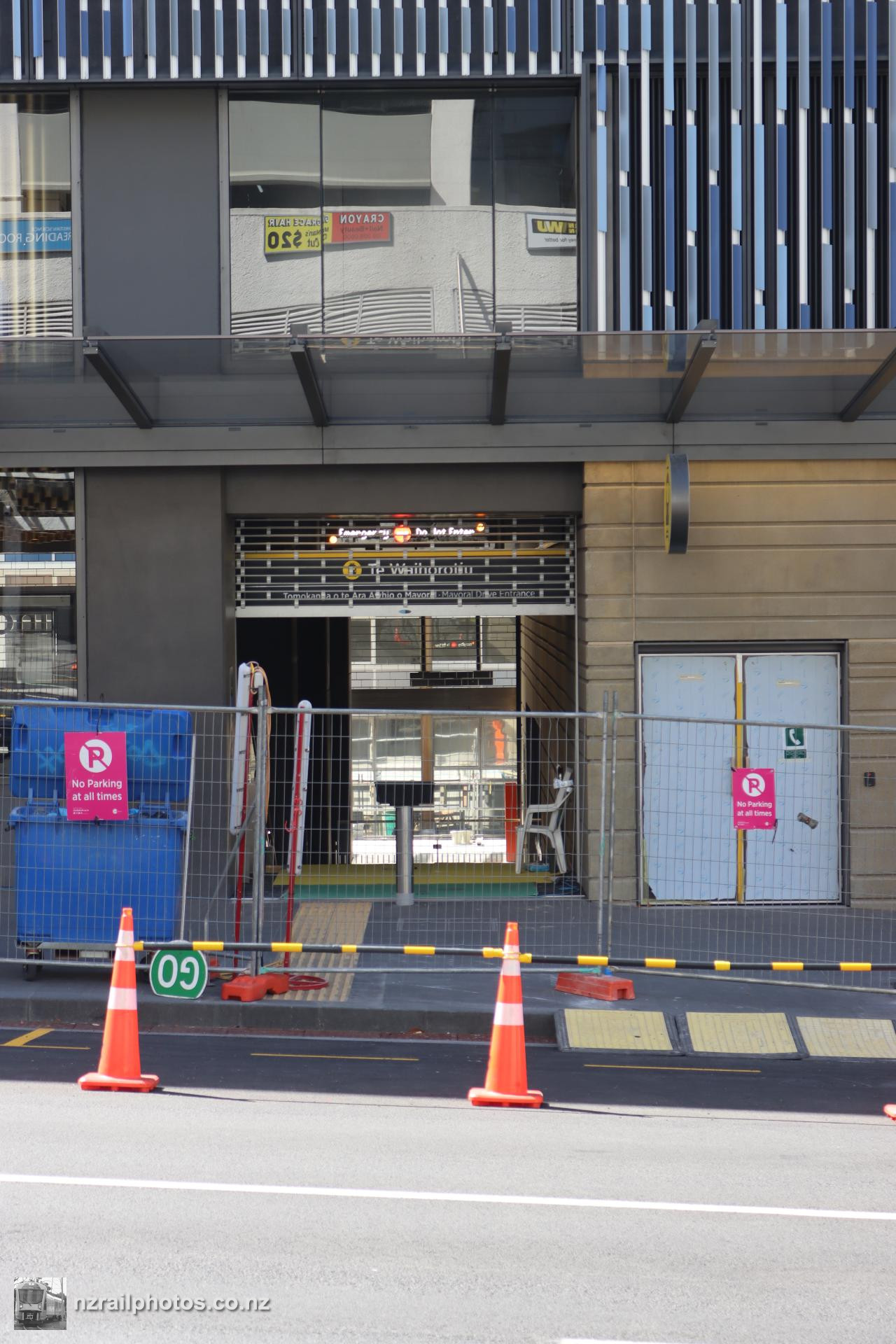

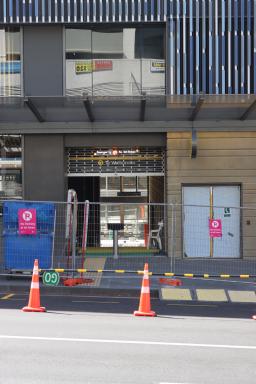

The main station building of Te Waihorotiu station, on the corner of Mayoral Drive and Wellesley Street West

18 January 2025

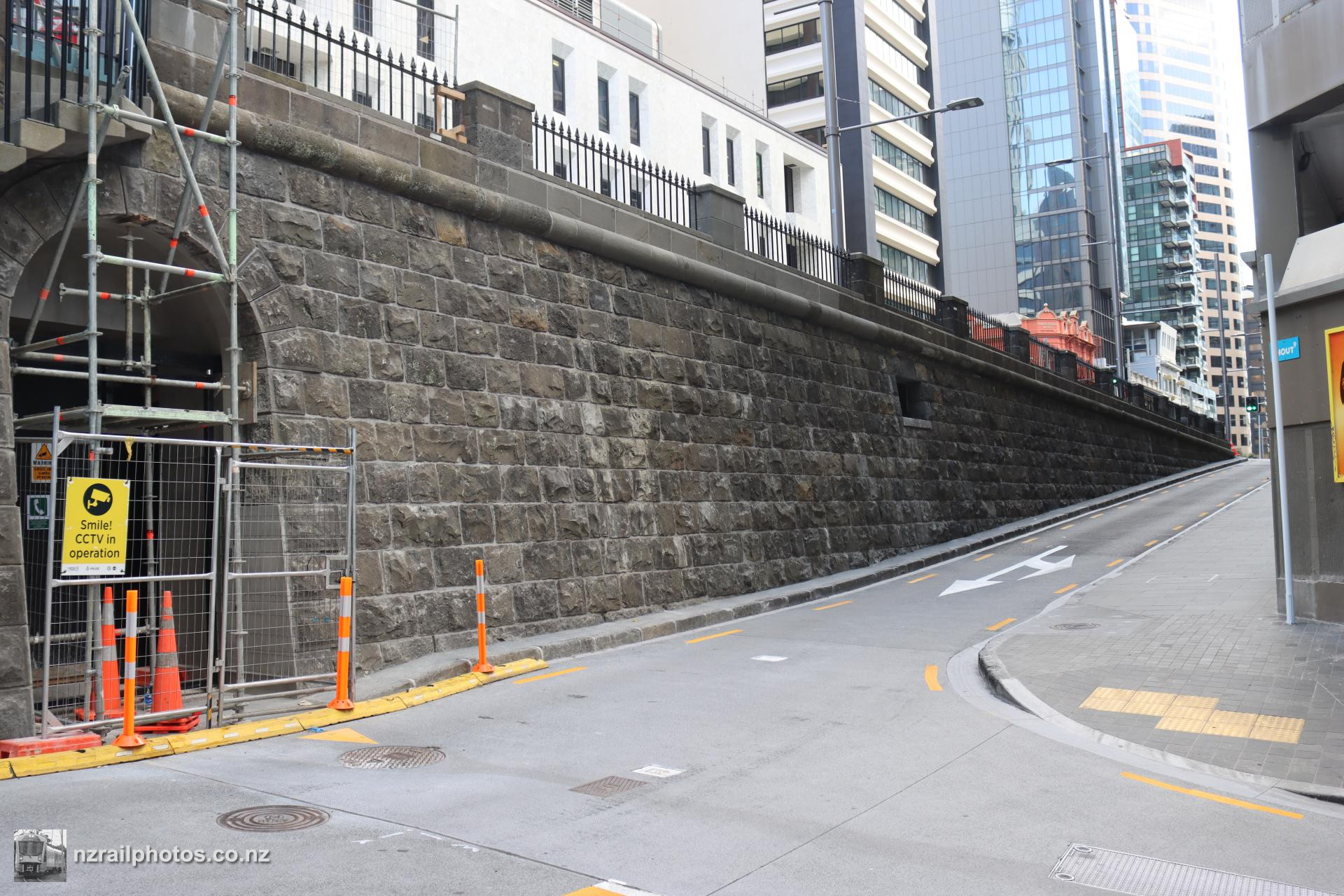

On Durham Street West, the 1881-built bluestone wall that was removed for CRL construction is now being reinstated. Each stone was numbered and carefully stored for eventual restoration, with the wall now sitting a few metres further east but otherwise in its original location

18 January 2025

With the heritage wall partually restored, two eras are clearly visible - the 1881 bluestone wall and the late 2010s era concrete railway tunnel

18 January 2025

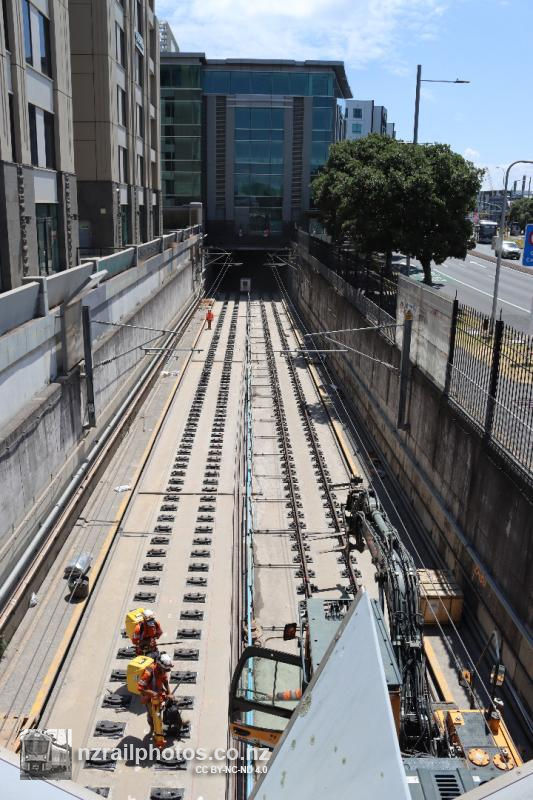

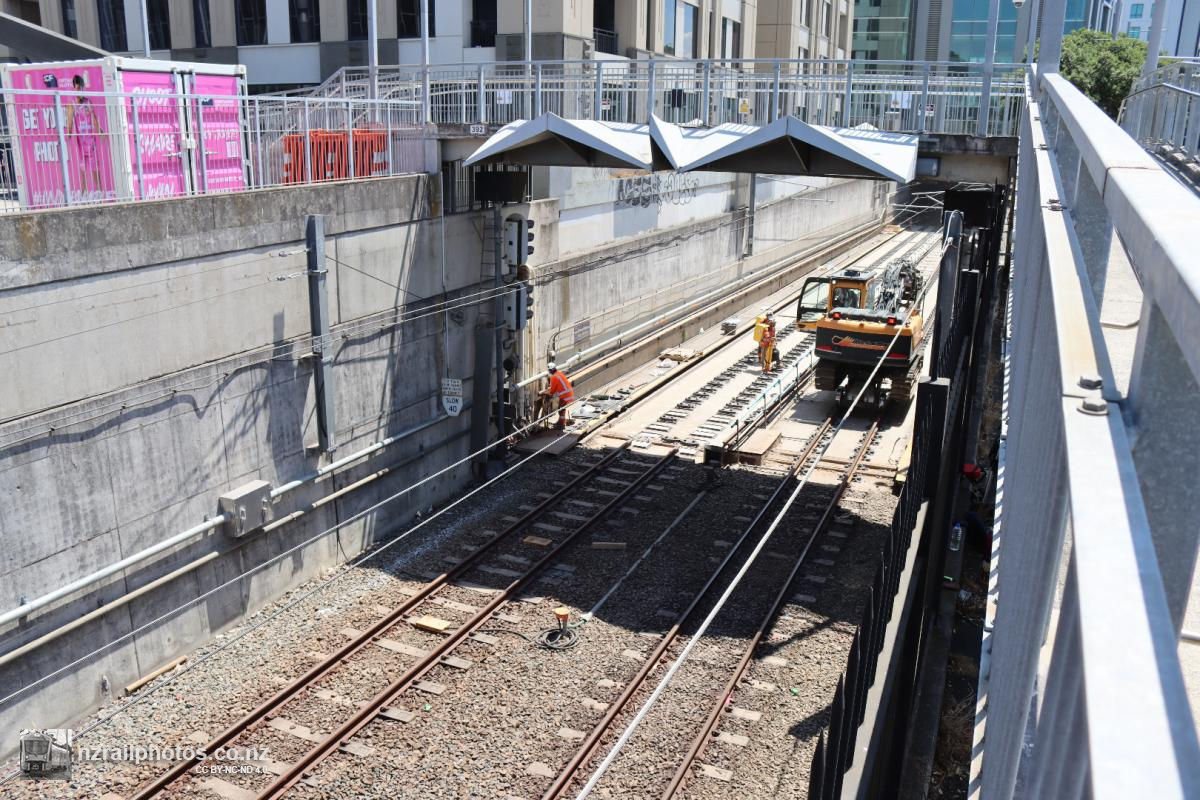

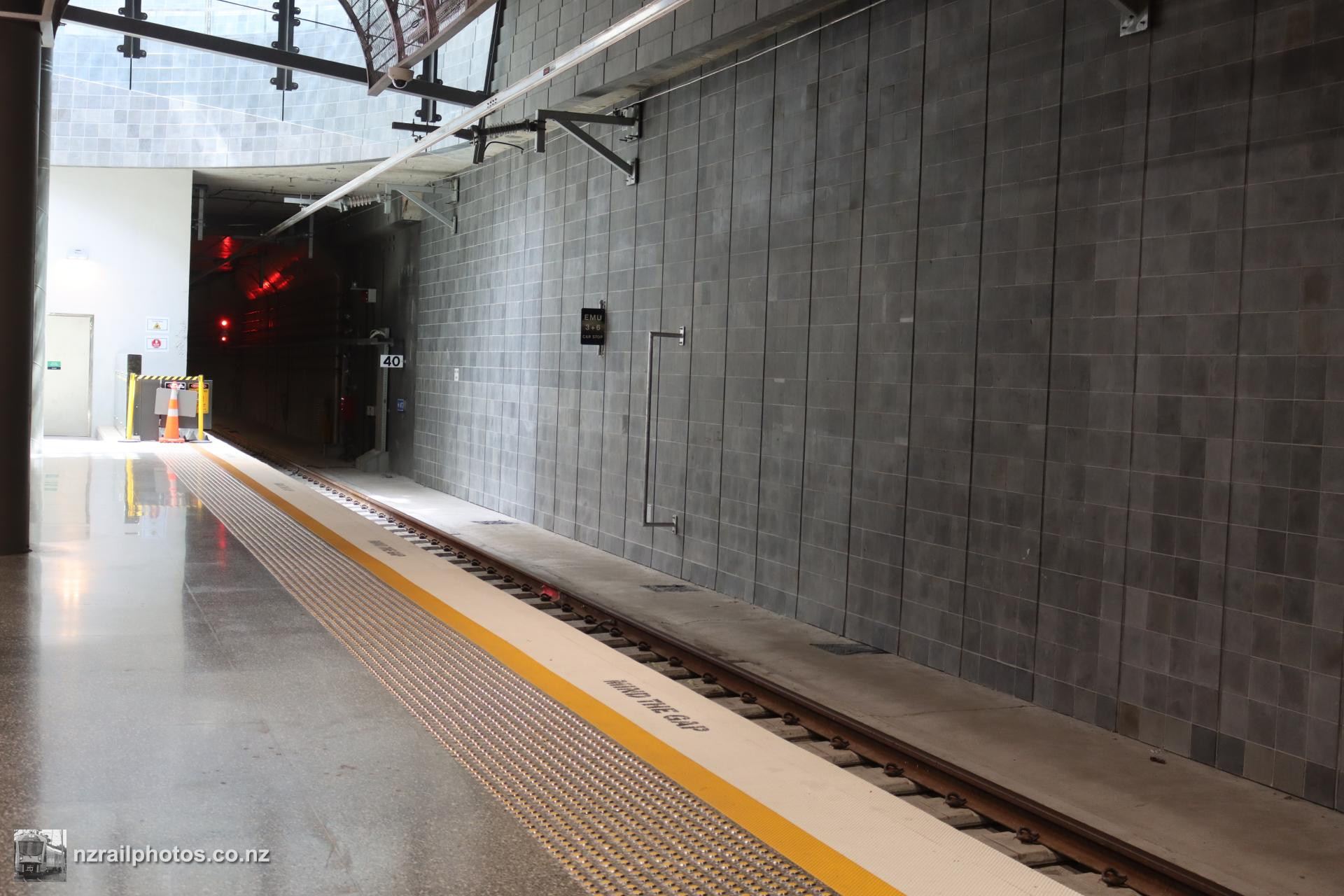

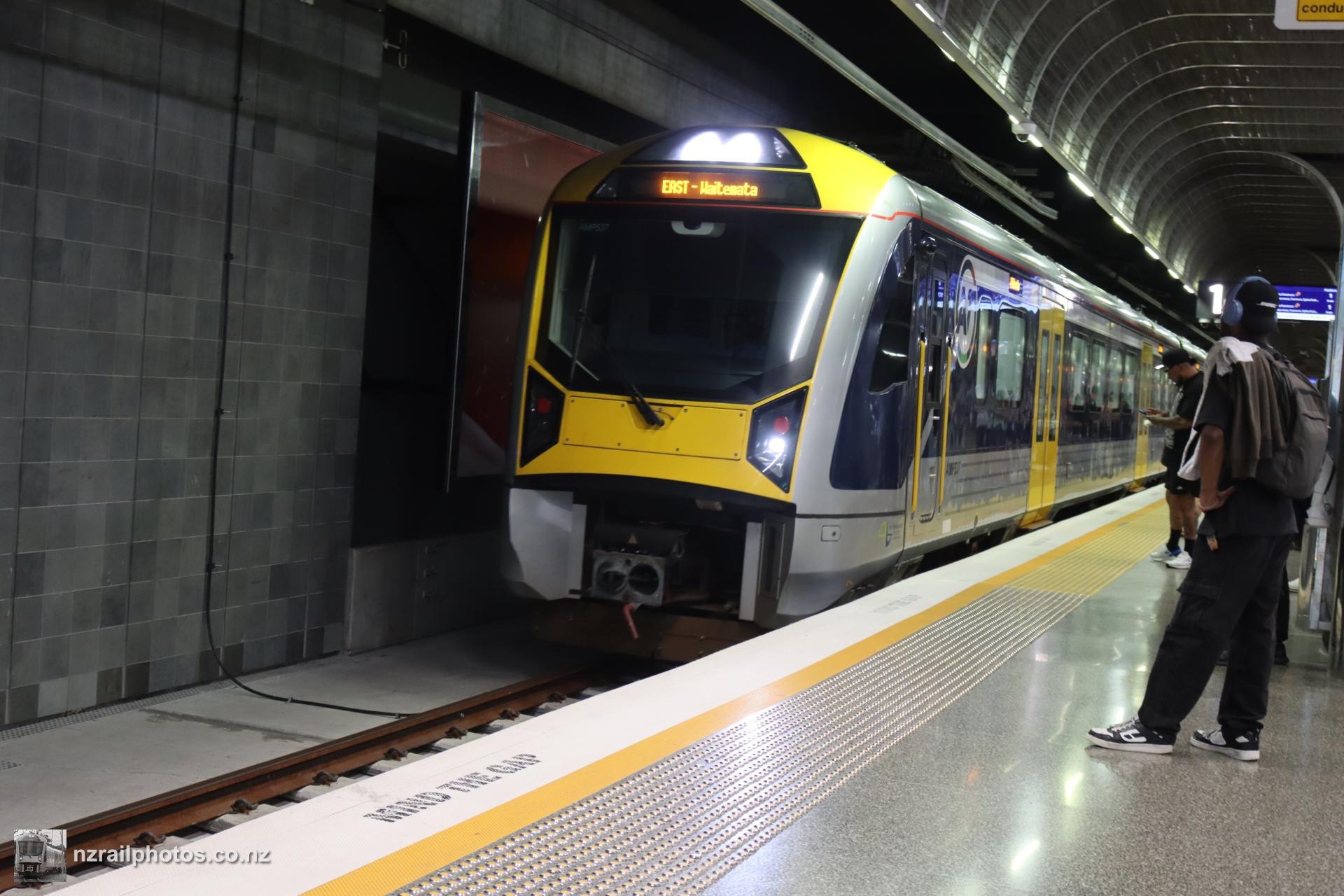

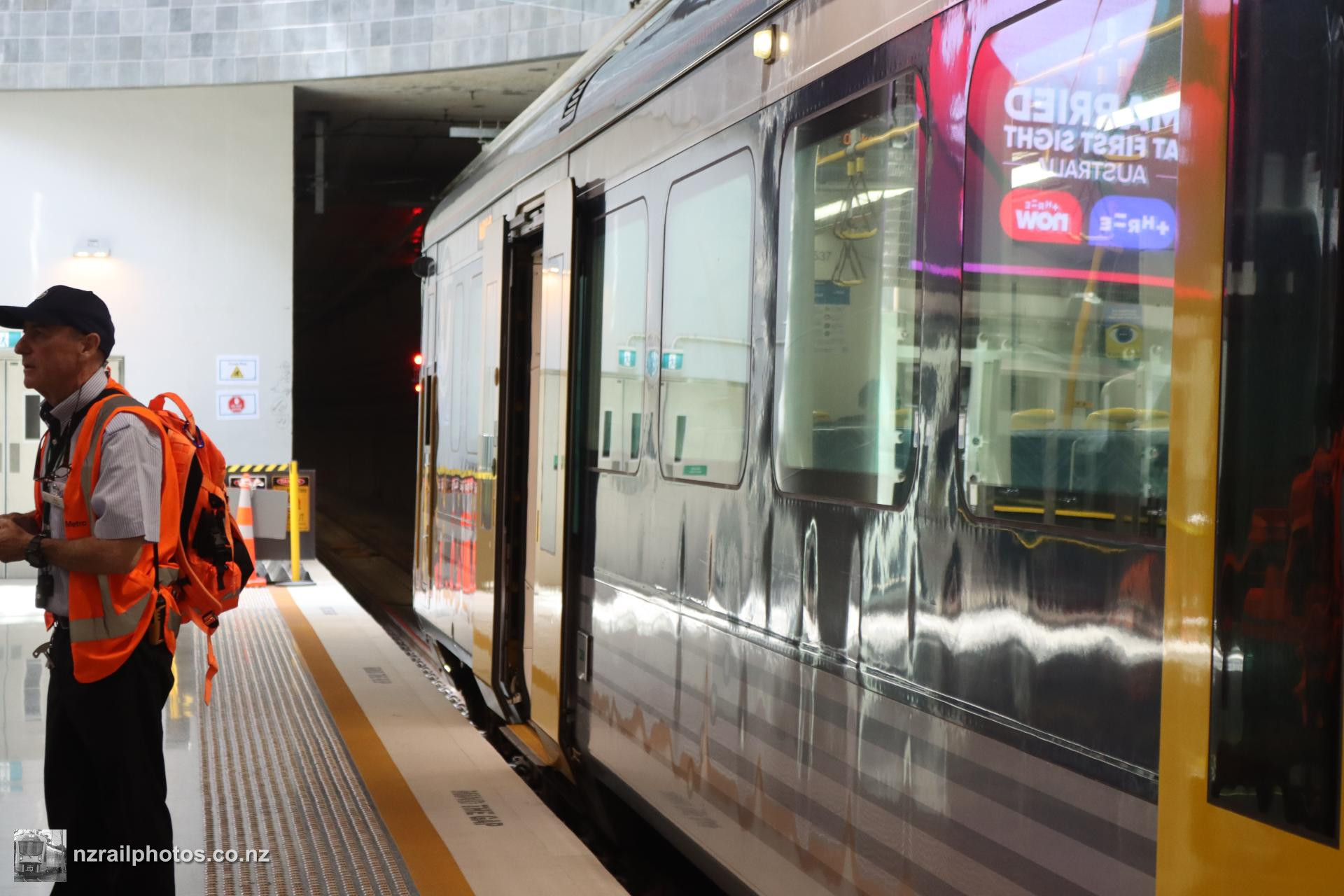

At Waitematā station, the track in the Britomart tunnel is being converted to slab track, in preparation for CRL opening

18 January 2025

The transition point for the slab track sits underneath the footbridge

18 January 2025
